It is important to appreciate all the things that are involved in implementing package
systems in order to better understand what is different and important for rapid
implementations. These are extremely complex projects at the detail level but are
relatively easy to understand at higher levels. This chapter provides a conceptual
framework for these projects by walking you through the activities and tasks that
occur in the various stages of a rapid implementation.
The implementation process, for a single project, is divided into several stages. At
a higher level, the term phases refers to multiple projects or versions that an application
or a business process goes through as it evolves to meet the changing needs of
business.
For example, in phase 1, an organization may put in the general ledger module
from a vendor's suite of packages and in phase 2 (a separate project) it may implement
the accounts payable module from the same vendor. In phase 3, the organization
may go back and change the general ledger configuration to handle financial
processing for a new subsidiary. Under this scenario, the organization's financial systems
have gone through three phases of development through the work done on three
separate, but related, projects.
 |
| Interested in implementing software for manufacturing? |
| Download a PDF of this chapter |
|
|
 |
 |
Each of the stages of a rapid implementation project produces major deliverables
(e.g., reports, plans) for the project and serves as a milestone to show the completion
of a significant piece of work. The stages sometimes serve as a decision point to get
buy-in for what has been accomplished (e.g., vision, business case) and a decision to
proceed with the next segment of the project.
Generally, the same tasks occur in both traditional and rapid implementations.
However, as you will see, the ways they are organized and managed are different.
Figure 2-1 depicts the traditional approach to implementation. It consists of five
stages. Each of these stages is a major milestone for the project. The major deliverable that is created at the end of each stage is reviewed by management and a decision
is made as to whether the project should proceed to the next stage. Each stage is
completed and approved before the team begins work on the next stage. Unfortunately,
this approach does not produce rapid results.
Every software package vendor and consulting organization has its own methodology
for doing these projects. In the methodologies there is a formal work
breakdown structure. In the work breakdown structure, the stages are broken down
into activities, which are a logical grouping of project tasks that result in one or more
major deliverables. The activities are then broken down into detail tasks. In some of
the commercial implementation methodologies there are hundreds of activities and
thousands of tasks.
Even though they may do many of the same tasks that are defined by the traditional
methodologies, a rapid implementation team needs to approach these tasks differently.
In rapid implementation projects, many things have to happen in parallel.
These projects are also more iterative in nature and require more trial-and-error than
formal design.
In a rapid implementation there is no time to produce formal deliverables that take
weeks or months for management to review and approve before the team begins the
next stage of work. Things happen too fast. Management is consulted and involved
throughout the implementation but many of the decisions on scope and design are
delegated to the project team and key users. Also, the entire project is approved ahead
of time -- not just one stage at a time.

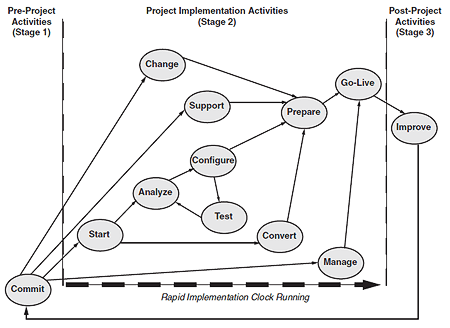

A rapid implementation is executed more like the diagram in Figure 2-2. This
roadmap shows the project's 12 major activities, arranged in three stages. This framework
will be used to provide an overview on the work done on these projects. It also
serves to highlight some of the differences from a traditional implementation
approach.
Even at a high level we can immediately see some differences with a rapid approach.
First, Figure 2-2 shows a lot of things going on in parallel throughout these
projects. It also implies that there is a lot of iteration and looping back and forth as
the project progresses. Finally, it highlights that certain activities must occur before
the project is formally kicked off and after it is completed. These pre- and post-implementation
activities are necessary for a rapid approach to be successful. They are
normally not adequately covered in traditional implementation methodologies.
We turn now to what actually occurs in each of the 12 activities on the rapid implementation
roadmap.
COMMIT
The Commit activities make up the preproject stage of a rapid implementation. They
occur prior to formal project kickoff. Many of the major decisions and actions that
ultimately determine whether a project is a success or a failure occur very early in the
life of the project. Many of these decisions create expectations for the project, which
serve as the standard against which the project will be measured. As a result, handling
preproject activities effectively is a key first step toward ensuring that the project will
be successful.
One of the primary reasons implementation projects fail is because there is insufficient
commitment to the project by top management. However, in order to get this
commitment, managers need to know what they are committing to. Therefore, a primary
concern of the commit activity is to define the project in terms of its objectives,
benefits, and expectations.
There are a number of steps that need to be completed before the implementation
project can begin. To start a project without completing these tasks puts the project
at risk. Here are some of the things to be accomplished during the commit stage:
- Select the project managers.
- Develop a business case.
- Set up the project team infrastructure.
- Prepare the initial project plans.
- Recruit the project team.
Select the Project Managers
One of the first things that must to be done is to select two project managers. One of
the project managers is the lead project manager, and comes from the organization
implementing the new system. The other project manager is the person from a consulting
organization or the software vendor who will coach the organization's project
manager through the implementation process. Once selected, these individuals will
do the high-level planning for the project and will be responsible for driving the project
to completion.
The lead project manager should be a highly respected individual with broad organizational
knowledge and contacts. This person will be ultimately held accountable
for the success of the project.
As will be discussed in more detail in the project staffing chapter (Chapter 5), a
consulting coach is needed because many key decisions are made early in a rapid implementation
that impact the ultimate success of the project. These decisions set the
direction and tone for the project and need to be made with the knowledge of someone
who has a lot of experience with these types of projects. An experienced consulting
manager also helps the organization's project manager avoid mistakes and
false starts throughout the project that could be fatal to a rapid implementation.
The coach brings a methodology for doing these projects, experience in managing
the risks of these projects, and an independent perspective. The organization's lead
project manager cannot be expected to have these tools and traits. However, for important
reasons that will be covered later in the book, the organization should not
have a consultant lead the project. This is a role for someone from the organization.
If the project managers were not involved in the package selection and justification
activities, they need to quickly get up to speed on a number of things: What is
the project really about? What is the expected scope of the project? What things are
specifically excluded from the project scope? What are the expected timeframes?
Who are the supporters and who is the opposition? What is the business imperative
for the project and how does it fit into the overall strategies of the organization? Much of this information is available from the project sponsor, those who participated in the software selection, and those who worked on the business case for the project.
Develop a Business Case
The business case is the next area to examine. The project managers must ensure that
there is a business case or charter for the project. The business case quantifies the
benefits and costs associated with the investment in new systems and business
processes.
Ideally, a business case was developed as part of the process of selecting the package
and justifying the investment to implement parts of that system. If so, this information
can be reviewed and updated at this time. If a formal business case was not
prepared, then, at a minimum, the high-level goals and objectives for the project need
to be put into writing and approved by the project sponsor and steering committee.
This may be documented in the form of a project charter. These goals and objectives
can be taken to a lower level of detail as required as the project progresses.
This business case will be useful in managing the scope, boundaries, constraints,
risks, expectations, and assumptions for the project. The assumptions include things
like whether the organization will modify the vendors' code or follow a strategy of
going with the vanilla version of the software and change business processes to the
methods supported by the package. The constraints might include the budget for the
project and a go-live date that must be met for critical business reasons.
Set Up the Project Team Infrastructure
The third step in Commit is to set up the project team infrastructure -- before the project
starts. This includes constructing the war room for the team with PC and phone
access for each team member. The team members should be connected to both a local
area network and development and test versions of the package software.
The IT support group for the project has a lot of work to do in setting up this environment
in time for project kickoff. Since the organization's personnel may not
have been to the technical training on the package yet, they may need the assistance
of technical support people from either the vendor or the consulting organization in
order to get these tasks done on time. In the early stages of the project the organization's
IS personnel are often watching, learning, expediting, and making sure things
get done to prepare a suitable technical environment for the team. As the project progresses
they will be setting up the production environment for the organization,
mainly on their own. After go-live, they will be responsible for supporting the new
system in actual use.
Other administrative aspects of the team infrastructure also need to be set up in
time for the kickoff meeting. The network (LAN) support for the project team (e.g., folder structure, access rights, email, calendaring process) needs to be established. Forms and policies need to be created for issues logging, status tracking and reporting,
and expense reimbursement. Many of these items will be covered with the project
team members in their team meeting following the formal project kickoff
meeting.
Prepare the Initial Project Plans
A number of plans need to be prepared before the project is staffed and started. One
of these is a risk management plan. The project managers need to assess all the things
that may cause this project to fail and those things that are key to its success. Plans
and actions should be identified to mitigate or respond to the risks and to ensure the
key success factors will be in place. These responses might include things like adding
additional steps and checks to the project workplan or staffing the project with more
experienced personnel in certain areas.
All of this should be documented in a risk management plan. If there is not support
for actions that are necessary to make the project successful, then the project
manager should address this issue with the steering committee. Perhaps the organization
is not ready to start this project at this time. After all, there is little use in starting
a project that has a high likelihood of failing.
A preliminary workplan should also be developed at this time. It lays out a
roadmap for the entire project. It will also be used in determining the proper staffing
level for the project. The project managers will not attach names to the various tasks
until they have finalized the team organization and evaluated each individual team
member's areas of interest, experience, and skills.
The project organizational structure and roles and assignments need to be developed
next. The same person may perform several of the roles. If the project is using
an application service provider or contract programmers, some of the roles will be
outsourced.
For a rapid implementation with a small project team there will be a flat organizational
structure. These projects do not need a lot of chiefs; everyone should be
doing direct, value-adding work. In addition, all team members will pitch in, wherever
required, to get the project complete on time while achieving its business
objectives.
Finally, the project managers need to determine the key deliverables that will be
created in the project. There will be hundreds of deliverables described in the
methodology used by the vendor or the consulting organization. But, in line with the
philosophy of doing only value-adding tasks, the project managers need to decide
what are the really important, and therefore mandatory, deliverables from a rapid implementation.
These deliverables will guide the activities for each task, control the level of detail that the team members go to, and help the team members know when they are done with a task. The deliverable plan should also address whether the team will
require signoff of the deliverables by the end users, the sponsor, or the steering
committee.
Recruit the Project Team
The final step in this activity (and stage) identifies those people that will make up the
core implementation team. A deliberate effort should be made to recruit the best possible
people to be on the team. A lot more will be said on this topic in the chapter on
staffing these implementations (Chapter 5). However, it should be noted at this time
that the quality of the people who will work on this project is one of the keys to its
success.
In a rapid implementation, management is going to have to empower the team to
make a lot of the detail decisions that will affect the way future work gets done in the
organization. The team members will be required to come up with creative ways to
use the package to accomplish what has to be done. They will have to do this under
intense time pressures while facing resistance to the changes that will be made from
many areas of the organization. This is a lot to ask. Therefore, we need an organization's
A team for these projects.
If the tasks covered in the Commit activity are not completed before the project
kickoff, it will be difficult for the project team to hit the road running. Good planning
and preparation before project kickoff gets the project off to a good start.
START
The Start activities initiate the project implementation stage of a rapid implementation.
This activity officially begins with the project kickoff meeting. This meeting
normally takes a full day. In attendance during the morning session should be several
top managers of the organization, the steering committee members, key functional
managers, the project team, and representatives from the vendor and consulting
firms. The afternoon session is just for the project team.
This meeting should be preceded by individual discussions with the project sponsor,
the steering committee members, and other key managers. With these meetings,
the project managers begin the process of building understanding and commitment
for the project throughout the organization. There should be no surprises in the kickoff
session.
The organization's project manager should lead the kickoff meeting. However,
the most senior executive present should open the meeting with a statement that describes
the importance of the project to the organization and the support the team has from top management. It is also useful for this person to lay out some rules of the road for the relationship of the team to the rest of the organization. Some sample rules
include:
- Top management expects the departmental managers to make time to be involved
with the project.
- The organization is using a rapid implementation approach because management
believes it is the best way to accelerate the benefits of the system and respond
to quickly changing business requirements. As such, rapid implementation
will become a core competency for successful organizations.
- This approach will require the organization to limit the scope of this project. The
organization will go live on the new system with all the processes that are ready
on the target date. Some good capabilities of the vendor's package will have to
be deferred to later phases.
- This approach requires numerous trade-offs. It will only succeed if it has the
support of all areas of the organization. Since the future of the organization depends
on learning how to do these implementations rapidly to meet critical business
requirements, top management expects that the team will get full support
from all departments.
- This is not a one-time effort. The organization will do a lot of these rapid implementation
projects in the future. Therefore, we need to evaluate the process
and capture lessons learned so they can be applied in future projects.
- These projects will be successful only if there is a great deal of user involvement.
Therefore, we expect the departments to do whatever is necessary to make
their people available for the tasks that require extensive user involvement.
- Top management will not allow individuals and groups to criticize the project
and the team behind their backs. If people have a problem with the way the project
is going, they should bring it to the attention of the project manager or the
sponsor.
- The organization is implementing this new application software in order to have
the ability to change business processes in the future and have them supported
by the vendor's products. This software has a lot of flexibility in the way it can
be implemented. We will not modify the vendor's code to meet the way we do
things currently.
- I have instructed the project manager to come to me with any roadblocks to the
successful completion of this project that cannot be resolved by the sponsor or
the steering committee. I will make whatever decisions and take whatever actions
are necessary to support the successful completion of this initiative.
One of the first indicators of the importance of the project is whether the representatives
from top management stay for the entire morning session. Another will be the actions top management and the steering committee take to keep this project on track when the inevitable bumps in the road appear. With swift response to resolve
the first few project problems, word will get out that something different is going on
with these rapid implementation projects.
By this time most of the steps from the Commit activities should have been
completed. For example, the workspace is ready, and the team members have been
transitioned off their old jobs. It is very disruptive to project progress for the team
members to join the project at different times. Those joining the project late miss a
lot of the team-building activities and initial training and planning that occur in the
first weeks. No matter how hard they try, they often stay behind the others for most
of the project.
If all the Commit activities were not done by the project kickoff, they should be
completed as quickly as possible at the beginning of this activity. However, it is not
a good sign for the project if there are a lot of these activities to complete.
The other main step that occurs in the Start activity is providing initial training for
the project team members. This training should be scheduled in the four or five days
that follow the kickoff meeting. Initial training should cover the methodology and approach
that will be used for the project and provide an overview of the design and capabilities
of the software package.
Many of the team members may not have been on the software selection project
and therefore may never have seen the vendor's system. It is important to get them
into the software quickly. Therefore, these first training sessions should minimize the
amount of slide show-based lectures and provide, instead, some hands-on training on
things like signing on and navigating through the system, as well as having actual demos
of the software by the trainers.
A difficult decision is whether the team should be given the standard training
from the vendor at the vendor's training site or receive a tailored version at the organization's
location. The problem with the generic training is that it will cover a
lot of capabilities in each of the package's modules that are not within the scope of
the implementation -- and may never be used by the organization. Also, if team
members train at the vendor's training locations, they will usually be in classes
with people from a lot of different organizations. In these situations a great deal of
the class time can be spent answering questions that are relevant only to other organizations.
However, there are benefits from the team members seeing all the capabilities of
the system in the vendor's generic training. After this exposure, they may be in a better
position to identify functions that could be implemented in the future.
Using tailored in-house training has the advantage of focusing the training on the
specific needs of the project. This approach should simplify the training by reducing
the number of areas that have to be covered. It also is more in line with the overall
philosophy of eliminating non-value-adding or low-value-adding activities from
rapid implementation projects.
No matter which training approach is chosen (generic or tailored), the project team usually benefits from receiving the initial training as a group, near the organization's site. This is often easier on the project budget since it minimizes travel expenses for
a large number of training attendees.
MANAGE
This activity includes all the things the project managers do to plan and control the
project. In a rapid implementation, the managers act a lot like player/coaches. The
teams are small and the organizational structure is flat. So, the managers spend a lot
of their time doing on-the-job training with team members, offering suggestions, providing
examples, guiding the work, reviewing deliverables, and removing barriers in
the team's path.
The project workplan is a key tool for the project manager. It lists all the tasks that
have to be accomplished before going live with the new system. The project is
planned and controlled by means of this document.
The project workplan must be a living document that is used and updated throughout
the project. Too often, the plan is prepared at the beginning of the project and then
never reviewed, used, or updated. This is unfortunate, because the workplan is the
primary tool that helps the project manager determine how things are really going.
The project manager determines project status by reviewing and accepting deliverables
from the team members. In this process, there are only two task states that are
important: the task is either (1) complete or (2) still in process. The practice of asking
people for estimates of the percent of each task that has been completed has
never been an effective way for determining project status.
The tasks should be defined at a level where each one should take no more than
two days to complete. At the appropriate time, the project manager sits down with
each team member and reviews the deliverables from the task. They are either done
or in process -- nothing in between. If there is no completed deliverable, the task is
not done. Although this may seem simplistic, it is difficult to fall weeks behind
schedule and not know about it with this approach.
One of the requirements for rapid implementation is templates or sample deliverables
for most of the tasks. They are key accelerators for project activities. It is much
easier for team members to tailor documents than create them from scratch. These
sample deliverables help define the level of work for each task and provide a consistent
format for the documentation. A key project manager task is to select the templates
for the project and teach the team members how to use them.
The project manager is responsible for the performance of the team members. If
team members cannot carry their assigned part of the load, or have problems that
cause them to disrupt project activities, they must be replaced. The project manager
must address these problems quickly and decisively. With a flat organizational structure
and aggressive schedule, the project managers cannot spend a lot of time counseling and correcting the work of any specific team member. Project manager time is needed in all areas.
Risk management is also a key task for project managers. They must anticipate
things that could go wrong in the project and do whatever is necessary to prevent
them from occurring. For those risks that are outside the control of the project team,
contingency plans should be developed to allow the team to respond quickly to minimize
impact on the project. The team must be able to make quick course corrections
during the project.
The project managers are responsible for developing the team members. These
projects are great opportunities for knowledge transfer and provide team members
with a broad understanding of how the organization works. Team members become
valuable assets to the organization once the projects are completed. The project managers
should look for opportunities to take advantage of the knowledge and experience
the team members bring to the project and give them opportunities to develop
new skills and knowledge.
The project managers are responsible for keeping the team focused on the goals
and objectives for the implementation. Time is valuable in these projects. Every task
needs to be challenged to determine the value it provides toward meeting the project
goals and objectives. Non-value-adding tasks must be eliminated.
A big part of managing these projects is managing the scope of the implementation.
To a certain extent, the detailed scope is not known at the beginning of these
projects. The team has project goals and objectives but does not know all the detailed
transactions that will be included in this current phase of the package implementation.
Therefore, there is a continuous process that defines the scope in more detail.
Deciding and documenting all the things that are not included in scope is equally important
to the success of these projects.
Finally, issues management will be an ongoing task for the project managers. The
issues (e.g., problems, opportunities, decisions) need to be identified by all the team
members and then prioritized and resolved. In a rapid implementation, the team cannot
take weeks or months to resolve issues. They must be taken care of in a matter of
days. Therefore, a useful project metric is how many unresolved issues are in the
issues log at any one time and how long is it taking to resolve them.
Chapter 4 covers project management approaches, activities, and responsibilities
in more detail.
ANALYZE
In the Commit and Start activities the organization establishes a vision and business
imperative for implementing the new system. Also, goals and objectives for
the project are documented in the business case or project charter. In this activity the implementation team will determine how to achieve that vision and meet those objectives.
What does the new system have to do to support the desired business process
changes? How will the organization use the standard software to achieve these
changes? To answer these questions, the team will have to determine how the new
subprocesses will work using the capabilities of the package.
This activity is the analysis and design portion of the project. It is where the team
puts on its business hat and gets creative about how to improve business processes
and solve business problems. It means looking at the as-is processes and determining
how they will change going forward. These activities require knowledge of the business
and its processes, as well as the capabilities of the software package being implemented.
This portion of the project also requires creativity and a focus on finding
the simplest, best ways to do things within the capabilities of the vendor's software.
The team analyzes how work is being done now and the problems that people experience
with the current process design and technology support. They look for new
opportunities and ways to do things that are possible because of the rich capabilities
of the package that has been selected. They determine what has to be done within the
new system to support the business in the areas that are included in the project's
scope. In these activities the team determines the requirements for the new system
and begins designing ways to meet these requirements.
Designing new processes addresses how the organization will get information into
the system, what processing and decisions will occur (either manually or within the
system), and what will be the outputs. These outputs may be in the form of reports,
business forms (e.g., checks, invoices), updated databases, and inquiry screens that
provide information and help evaluate the results of processing. All these requirements
for the new system will be documented in a design specification.
In the past, design specifications were turned over to programmers to code using
programming languages, such as COBOL, C++, Visual Basic, or PowerBuilder.
Once the programs were written, there was extensive testing to ensure the programs
worked as designed. This testing occurred on two levels. First, the programmers
tested whether the system worked as they interpreted the requirements in the specifications.
Second, the analysts and users tested to determine whether the system
worked as they had intended when writing the specifications.
This approach for computer system development has been going on for almost 50
years. It still is used in the development of custom, standalone systems, bolt-on functionality
to augment a package's functions, and interface and data conversion programs.
However, development gets done differently when using a standard software
package and a rapid implementation approach.
The main difference is in the nature of the work that occurs after the team determines
the requirements for the new system. Rather than designing a new system in
the traditional sense, the team members select from a menu of transactions and package functions and determine how these functions can be configured to fit the needs of the organization.
This difference makes sense when you consider that standard software has already
been designed and programmed. The vendor, with the assistance of its customers, has
gone through years of requirements definition, data modeling, program design, coding,
and various levels of testing. This cycle occurs many times as the vendors provide
new releases of their packages.
The vendor's developers have done extensive testing of their own programs and
how they integrate with other programs in the application suite. Then, after they believe
that the product is relatively stable (and they have completed alpha testing),
companies are recruited to act as beta test sites -- to become the first actual users of
the software. These beta customers help find additional bugs in the software that can
be fixed before the package is made generally available to the public.
In addition to providing tested software, the vendors also have developed system
documentation, training programs, implementation templates and accelerators, process
diagrams, and data conversion utilities. In some cases, they have developed interfaces
to popular packaged software modules offered by other software vendors.
These are all resources that the project team does not have to develop from scratch.
Therefore, in a package implementation project, the team starts from a different
place than it would for a project to custom-develop a new system from scratch. If the
organization has chosen a good package and it supports a preconfigured version for
their industry, the project team may have a complete, fully functioning system to
work with in the first weeks of the project. However, that still leaves a lot of work to
be done.
The standard software usually has several different methods for supporting most
processes. So analysis activities focus on selecting which parts of the system will be
implemented in this project and determining how to enable these parts of the package
and tailor them to meet the needs of the organization.
Lists of all the transactions supported by the system can be annotated to show
those in the scope of the project. Process diagrams showing the processes supported
by the package can be used for the same purpose. Either method generally shows that
most organizations use only a small subset of the total functionality of the top packages.
The challenge is to determine what parts of the system must be used to meet the
business requirements. Other parts of the system can be implemented in future phases
as part of the Improve activities.
For the tasks discussed in this activity it should be obvious that the team needs to
understand both the as-is and to-be business processes and the capabilities of the
package. The organization's personnel on the team usually understand the organization's
current processes very well. However, they usually rely on the knowledge of
vendor personnel or consultants on the team who have experience with the package
to provide the detailed package knowledge.
As the project progresses, the core team members learn a great deal about the system
through additional training, discussions with vendor and consulting personnel,
and hands-on experience with the software. There will come a point when all the
team members know the package well. After that knowledge transfer has occurred it
will be possible for the organization to do these tasks in future implementations of
this package with much less consulting support.
The team uses two primary guidelines in making scope decisions during the Analyze
activity. First, they need to include enough functions and processes in the scope
of the project to address the major problems to be solved and benefits to be achieved.
Second, the organization must still be able to carry on its normal work (e.g., manufacture
and ship goods; register, teach, and administer student records; bill patients)
after it goes live with the new system. These implementations should be transparent
to customers -- or should delight them with improved service.
Since the team is not implementing all the functions of the package in the first
rapid implementation project, they must determine how the other processes in the
businesses will continue to get done. This usually means interfacing the packaged
software with legacy systems and employing short-term workarounds so the work
can still get done while later implementation phases are completed.
The deliverables from of all this analysis work will include documentation, at a
high level, that shows how the processes will work in the future to meet the project's
business requirements. It will also include a delineation of the parts of the package
that will be used to support these processes.
The Analyze activities are shown on the roadmap in Figure 2-2 as part of an iterative
loop of analysis, configuration, and testing. The team will not get the analysis and design
right the first time they try. They may decide that they can use the system in a certain
way only to find out that that approach will not work. During testing they may learn
that the package works in a way that is different from what was thought or could be determined
from its documentation. On a more positive note, as they learn more about the
package and its capabilities, the team may find an easier way to support a process.
During testing and review, key users may surface problems with the design that
require the team to find alternative ways to perform processes. The team may also
find that some parts of the process are not supported in the current version of the software
and, therefore, must be handled with legacy systems, bolt-on functionality, or
workarounds. As a worst case, the team may even find that some of the objectives of
the project are not supported by the package and cannot be achieved in the initial
implementation.
These issues are all part of the challenges and messiness inherent in implementing
any new, complex application system. However, after several loops through Analyze,
Configure, and Test the team will usually come up with a way to support the
business processes with the package capabilities. Then they must configure the system
to make it work as designed.
CONFIGURE
Configuration requires detailed knowledge of a vendor's package. Each of these
packages has hundreds and thousands of parameter tables that are used to change the
way the software works in order to address different business methods and procedures.
Changing these parameters is how the team tailors the software to meet the
unique needs of the organization. Certain parts of the package need to be turned on
and other parts disabled. There are often several different ways the package can be
used to support a particular business process. The team must select and enable the alternatives
that best meet the organization's needs.
Configuration also maps the organizational structure (e.g., companies, departments,
cost centers) to the software database structure. This mapping can have significant
implications for reporting and processing of intra- and interorganizational
transactions. The system can often be set up to represent one organization with all the
related entities as components or it can be set up with each entity as a separate, related
organization. These decisions determine how transactions between related entities
are handled by the package.
In addition to choosing parameter options and organizational structures, the team
defines a financial chart of account and other system codes. These numbers and codes
tell the system how to account for and validate the various transactions that occur
during processing.
A major risk in configuration is not identifying the "load-bearing walls." These
are choices that the team must get right in the initial configuration because they are
difficult, or even impossible, to change at a later time. There are many other configuration
parameters than can be changed on the fly, at any time, to alter the way the
system works. The key is to know how easy it is to switch specific configuration decisions
in response to project or business changes.
The nature and number of configuration parameters, and the ease of changing
them, varies among the vendors' packages. Some packages have a reputation (e.g.,
SAP R/3) for great functionality (supporting all the ways an organization could want
to perform its processes) but a requirement that the team get configuration decisions
right the first time. Other packages seem to be more forgiving of the need to change
decisions in the future. In general, the things that are difficult to change are those that
affect the way information is organized in the package's databases.
Packaged software needs to be able to be changed continuously to support business
strategy and process changes. Making significant changes in some packages can
be a difficult and cumbersome process. Other systems are more flexible and can handle
certain changes more easily. However, flexibility is a relative term.
There are certain things that are easy or difficult to change in every package. However,
the ease of making other changes varies by software product. Some vendors
(e.g., J. D. Edwards) market that their product is so easy to change, in response to changing business requirements, that "you can change the tires while going down the road at 60 miles per hour." The truth in all these claims, pro and con, needs to be
tested with real-world examples.
Configure is part of the Analyze-Configure-Test loop. The team will find situations
where the package cannot be configured to do what has been designed. Also,
errors will be made in configuring the package that will be caught and corrected in
testing. Additional configuration tasks occur throughout the project as transactions
and processes are added and deleted from the project scope. Each of these situations
requires the team to cycle through this loop many times.
TEST
The testing that occurs in this activity is primarily at the transaction level. The team
is testing whether the individual transactions can be successfully completed with the
way the system has been configured. Examples of things to test at this point might be
the ability to enter a new customer, take an order, ship goods, receive materials, prepare
an invoice, enter a purchase requisition, or print payroll checks.
The tests designed and conducted at this stage require an in-depth knowledge of
the business requirements and how the package works. The core implementation
team can provide some of the business knowledge based on their experience working
in different areas of the company. However, this is one area of the project where
the team needs a lot of end-user involvement to define the detail requirements.
The testing activity involves seven steps for each of the transactions included
in scope:
1. Create test cases.
2. Prepare test data.
3. Define the expected results.
4. Run the test.
5. Evaluate the test results.
6. Correct problems and retest.
7. Document successful completion of the test.
For each transaction there may be several scenarios or cases to be tested. They
usually cover the normal things that occur as well as the exceptions. To get a flavor
for the level of testing in this activity, consider some of the things that may need to
be tested for a single transaction such as Enter a Sales Order (SO):
- Enter an SO with just one line item.
- Enter an SO with a large number of line items that require multiple entry
screens.
- Enter an SO that causes a customer to exceed its credit limit.
- Enter an SO that gives the customer a price discount based on quantity breaks.
- Enter an SO with a manual override on the discount percentage.
- Enter an SO where items are not available in stock and must be back ordered.
- Enter an SO using the customer's item number instead of the organization's
number.
- Enter an SO where the customer is exempt from sales tax.
- Enter an SO where freight charges must be calculated.
- Enter an SO where the customer will pick up the item at the shipping dock and
should not be charged for freight.
- Enter an SO for an item that is not carried in inventory but can be special
ordered.
- Enter an SO where the items must be shipped from several distribution centers.
- Enter an SO that is a release from a blanket order recorded in the system.
Although this list is not complete, even for this one transaction, it gives an idea of
the level of detailed testing that needs to take place for each transaction. For each of
the cases above there may be one or more tables or switches that need to be set in the
system (configured) for these situations to be processed correctly.
The end users who process transactions with the existing systems should be involved
in identifying all the different test cases. They know all the variations that occur
as a result of business policies and unique customer requirements.
All the test cases should be documented in a testing log. This log can also record
the results of each cycle of tests and the actions that were taken to correct errors.
Finding errors is a good thing! The project team does testing to find errors; they
should not expect that all the tests would run the first time without error. The idea
is to find the errors early, when they are easy to correct. The team also wants to
find and correct the bugs before the system is used to train users or process real
transactions.
In order to run these tests, it is necessary to set up test data in the system. For our
simple sales order tests we need customers, items, multiple distribution centers, and
pricing, freight, and sales tax tables. At this stage of the project the team does not
want a large numbers of items in the test databases because that would make it more
difficult to trace the transactions. Therefore, the team should not dump all the production
data from the legacy systems into the test databases. Rather, they should create
the minimum amount of test data to run the tests identified.
However, it is helpful to use actual customer names and item numbers in the tests
so the end users can relate to the test scenarios. Often a small amount of data can be entered manually using the entry screens in the system. This implies a hierarchy for the tests. We need to test entering a new customer and changing credit limits before
entering transactions for our sales order tests.
A key step in the testing process that is sometimes omitted is documenting the expected
results before running the tests. Experience has shown that the expected results
need to be put in writing to support an effective testing process. Without this
step, people evaluating the test results may check only part of the outputs that are produced
or accept the results without sufficient thought or challenge.
As examples, the expected results from sales order tests could include:
- As SO 10887 is created, the five items in inventory for this SO should be reserved
for the quantities on the SO and the available-to-promise amounts for
each item should be reduced accordingly.
- The customer in test case 4 should have its credit status field changed to "COD
only."
- The freight charges for test case 12 should be $26.42.
- The sales tax for test case 14 should be $6.45.
- The freight charge on the pickup order in test case 15 should be zero.
Without documenting the expected results, errors can slip through the cracks and
not show up until later in the project when they are more difficult to correct. Even
worse, they may be discovered first, after go-live, by the organization's customers in
the form of incorrect invoices or wrong shipments.
Once the tests are run, the actual results and the expected results are compared.
This is not as straightforward a task as might be expected. When there are discrepancies
the team will sometimes find, perhaps after trying several changes to the system,
that the system results were correct all along and the expected results were
wrong. Researching result gaps requires a good eye and an open mind.
If the system does not perform as designed, it may be necessary to change parameters
or data tables to correct the problem. Before rerunning the test it may be necessary
to refresh the test data -- setting it back to what it was at the beginning of the test.
Running several test cycles corrupts the initial test data and the expected results for
future tests. Therefore, it is advisable to create a standard test bank (set of test data)
that can be used for all the tests. Then the IS support personnel need to provide a
mechanism to refresh the test data, as required.
A final testing concern is the fact that changing parameters to fix one problem
might cause new problems in another area. A test that worked correctly yesterday
might fail today. So, there is a need to run through all the tests multiple times until
the system passes all the unit tests in a process area.
The actual and expected results should be retained so project managers and others working with the team can review the tests. This documentation can be used to research other test problems later in the project.
Testing should go more rapidly if the team is using a proven, preconfigured version
of the software. A lot of simple errors that occur when setting up all the system
parameters from scratch can be avoided. The team will also be able to start testing
earlier with a stable, operational system as a starting point. So, in the areas of configuration
and testing, having a preconfigured version of the system is a key factor to
support a rapid implementation approach.
CHANGE
Putting in new computer systems produces significant benefits for the organization
only if the implementations improve key business processes. It is hard to cost-justify
these projects solely on improvements they make to the technical infrastructure.
Also, it is clear that there is little benefit from putting in new systems that are not
used. Therefore, to get the maximum return on application system investments, people
and processes have to change, and for the good. The organization must be able to
do things faster, better, or cheaper than they did before the new system was implemented.
The changes that result from a rapid implementation occur in three areas: (1) technology,
(2) processes, and (3) organizational structure. There will be many groups of
people who will be impacted by the changes. The responses from the project stakeholders
(i.e., those impacted by the project) will vary across the spectrum from denial,
active resistance, and a wait-and-see attitude to excitement and support.
It is not just management and the end users of these systems who must change. As
a result of these projects, the people in the IS department often must learn new skills
and utilize different tools in their work. In some cases the custom-developed systems
they created (and for which the organization relies on them for knowledge on how
they work) will be replaced by standard software developed by a vendor. For the first
time, users may know as much or more about the system as the application analyst in
the IS department. The implementation team may even be discussing the possibility
of outsourcing support and processing of the new system.
The users of the new system will be anxious because getting new systems usually
means they must learn new ways to do their work. It will change the way the work is
done as well as the tools that are used. The new system may replace the Excel spreadsheets,
Access databases, and three-ring binders they really use to do their job. It may
also change job roles and responsibilities. Users may also have concerns about how
quickly they can learn to use new technologies and complicated systems with different
terminology, screens, and reports.
Most of the users are not on the core implementation team. Therefore, they may
also have worries about the project team -- off in another building or location -- designing new processes without understanding all the problems and challenges users face on a daily basis.
Managers, especially supervisors and middle managers, often are concerned about
how the changes brought on by the new system will transform the organizational
structure and the roles, responsibilities, and authority of their department or group.
This is especially the situation when one of the stated benefits of the project is to cut
out a layer of middle managers. New business systems can sometimes be used to substitute
for one of the primary roles performed by middle management: acting as a
channel for passing information up and down from top management to the users.
In addition, the managers often designed the current processes and have a sense of
authorship and ownership for the ways things are done. Any suggestions for changes
to process designs may be taken personally.
All these issues, whether real or imagined, must be addressed during a rapid implementation.
The project team members must understand that perception is often
more important than reality. These concerns and fears are important because it is the
people issues, rather than technology issues, that usually cause these projects to fail.
Therefore, during a rapid implementation, the team must be proactive in managing
change. Given the shorter duration of these projects, the change will come
quicker to those impacted by the deployment of the new system. Positive changes do
not happen by accident. To ensure proper focus on these aspects of the project, someone
on the implementation team should be assigned primary responsibility for
change management.
There are a number of activities that can be done during a rapid implementation to
help manage the changes that occur. They fall into the following areas:
- Assessment
- Involvement
- Communication
- Documentation
- Training
At the beginning of the project, the team needs to assess the readiness of the stakeholders
for the changes that will occur. They need to determine the various groups
impacted by the new system and their views on the project. Who will be the supporters
for the project and who will be its enemies? What groups will be the potential
winners or losers in resources, power, and responsibilities once the new system
is implemented? Who are the leaders and influencers the team needs to win over?
What can be done to develop power users and champions for the new system and the
changes it produces? What do the stakeholders know about the project? How much
of what they know is accurate?
The project team will perform this change readiness assessment sometimes through survey documents but more frequently through discussions with a lot of people throughout the organization.
A key insight on human nature will have a dramatic effect on the success of the
project: no involvement, no commitment. The stakeholders need to be, and feel, actively
involved in the design, testing, and rollout of the new system. The implementation
team has to have a core group of people working full time on the project; but
a lot of other people need to participate in project activities. The nonteam members
need to provide information and advice on current processes, system requirements,
design alternatives, training approaches, test cases, deployment strategies, and organizational
changes.
The worst thing that can happen is for the users and managers to feel that their experience
and insights are not valued in the design of the new system. They must not
believe that someone else is determining their future without asking for their input.
One way to ensure that this does not happen is to proactively work on the two-way
communications between the team and its stakeholders.
There is no such thing as too much communication in these projects. Communication
needs to come from top management, the core team, and the extended team of
stakeholders. The themes to be communicated are simple: This is an important project
for the organization. It has the support of top management. This is when the new
system will go live. This is the status of the project. Several different methods will be
used to get the appropriate involvement of the people in the organization. These are
the ways the organization will ensure that people are ready for the new system and
their changed jobs.
The modes of communication are briefings at meetings, status reports, newsletters,
voice-mail, and email messages. And in this new web economy, the team may
even create a project web site, on an intranet or extranet, to communicate throughout
the organization.
Good documentation on the new system is important. Often there was never very
good written documentation for the old legacy systems. As a result users had to learn
through trial-and-error and from information passed down by more experienced employees.
With the fast pace of a rapid implementation, there is a need for better aids
to enable users to get up to speed more quickly.
The primary documentation for standard systems should be available from the
vendor in the form of system manuals and online help text. Often that information is
available in electronic format and it can be tailored to the needs of the organization.
In addition, the vendor or the system integrator should provide user procedures templates
and process flow diagrams to support development of customized user procedures.
These procedures can include policies and guidance on how the organization
will use the system.
The availability of quality documentation should be a requirement in the selection
of a package that will be implemented with a rapid approach. There is just not enough
time in these projects to develop this documentation from scratch.
The users must be adequately trained for a rapid implementation (or any implementation)
project to be successful. The people using the system need to be comfortable
in their understanding of how to do their jobs using the new system. Good enduser
training requires quality training materials and well-prepared instructors.
The key resources used in developing training materials should be the user procedures
developed by the core team and standard training materials available from the
package vendor. Increasingly, the vendors provide some of their training courses in
the form of CD or web-based just-in-time instructional materials. Most of the training
materials come in the form of instructor-led classes. The end-user training is
given in the Prepare activities, just before go-live.
Most projects will use a train-the-trainer strategy to deliver the training. Under this
approach, the core team members and power users attend vendor training sessions to
learn about the package and its capabilities. They also develop knowledge about the
system by working side by side with the consultants on the project team. These organizational
representatives then prepare and deliver the initial training to the end
users.
There are definite advantages in having people from the organization -- not the
vendor or the consultants -- deliver the training. These people can better teach the
users the new system because they are family, already have credibility within the organization,
and can use organization-specific examples throughout the training.
All these change activities are important in managing the changes that will result
from implementing new systems and business processes. Often they are either ignored
or short-changed. This happens because much of this work occurs toward the
end of the project, as time and budget are running out and the project is usually behind
schedule. However, these activities are some of the most important things that
must be done well to make a rapid implementation successful.
SUPPORT
Support refers to the IT activities that must go on, often behind the scenes, to ensure
that the rest of the implementation teams have a developmental sand-box in which to
test various system configurations. The IS personnel also work during the project to
prepare a production environment for use to process real transactions after cutover.
Although it has been stated several times in this book that a rapid implementation is
business-driven, there are still a lot of technical tasks that have to be done properly
to make these projects successful.
The IS department must get an early jump on creating a development environment
for the project team. Some of the tasks required to set up this environment have long
lead times. Since the team technical environment should be ready when the team
members return from preliminary training on the new system, most of these activities
must occur during the Commit period of the project.
The project war room must be set up with workstations for all the team members.
These workstations should be connected to a local area network so there can be common
access to all project deliverables and working documents. A phone should also
be available for each team member. In addition, printers, copiers, and fax machines
should be available in the project work area. The team will also need a display device
to project package screen images for meetings, demos, and testing.
The vendor's software must be loaded on a development server. This is often a
smaller server than will be used for the production system. If not already available,
this hardware and other network devices may have to be purchased for the project.
This same hardware can be used after the project is completed as a developmental environment
to test package upgrades, vendor code patches, and configuration changes.
This development system supports the project team, users who are assisting in the
design and testing of the system, and IS personnel developing data conversion, interface,
and reporting programs. In addition to the vendor's standard software, a
database management system and preconfigured versions of the system may also
have to be installed.
Once the initial development system is operational, representatives from IS must
assume the role of package system administrators and perform other technical support
tasks during the project. These support tasks include:
- Creating development, test, and production instances of the system and migrating
parameter settings and data between the different versions of the system
- Working with system security personnel or internal auditors to set up security
(access authorizations) for the project team members and researching, defining,
and establishing all the access capabilities for the end users of the production
system
- Establishing backup and recovery capabilities for the different instances of the
system
- Programming data-conversion programs and creating data files from the legacy
system that can be used to import data into the new system
- Tuning the databases so they operate efficiently with the new applications
- Supporting project team members as problems occur that require maintenance
on workstations, software, or peripheral devices
- Researching potential system bugs and working with the vendor's technical
support personnel to install code patches to resolve system errors
- Developing special reports and forms using the tools available with the software
and other common report-writing tools
- Developing program interfaces between the new system and existing legacy
systems so data can be passed back and forth between these systems in real time
or with periodic updates to system files
These activities require strong technical skills. Many also require knowledge
about the current systems used by the organization. Unfortunately, information about
legacy systems is usually not well documented and often exists only in the heads of
the IS personnel. Since most of these IT activities require significant amounts of detail
work, having full-time IS personnel assigned to the core team is critical to the
success of the project.
The new system may use technologies (e.g., databases, operating systems, development
languages, and tools) that are new to the IS organization. Consequently, IS
personnel must receive training on the technical aspects of the package while the
other team members learn the functional aspects.
To ensure the timely completion of the technical activities, the project team often
leverages the technical resources of the vendor and other organizations. Vendor personnel
may even install the software of the development server. In addition to this
initial support, it may be necessary to include, as a full-time member of the implementation
team, a technical consultant who has implemented this package before, in
the same technical environment. Even with these outside resources, there are a lot of
technical challenges to implementing these packages. A lot of IT knowledge transfer
and learning must occur throughout the project so the organization's IS department
can take on technical support of the system once it is put into production.
A new trend is to use an application service provider (ASP) to host the processing
of the system and take some of this load off the organization's IS department. If the
right ASP is selected and appropriate contract terms negotiated, this approach can
help manage some of the IT risks of the project. This option and a more detailed discussion
of some of the technical issues of implementation are covered in Chapter 7.
CONVERT
One of the potential hurdles to rapid implementations is the time that it takes to convert
data from existing systems into databases for the new system. The data conversion
challenges are in five areas:
1. Mapping
2. Cleanup
3. Loading
4. Verification
5. Synchronization
Mapping is the process of examining the information required in the new system
and determining where each piece of data will come from. This is complicated by the
fact that the new system will have literally thousands of data items in its database but only a subset of these are required fields. Therefore, a first step is to determine which fields will have to be populated before going live on the new system.
The fields that will be required depend on the transactions included in the scope
of the implementation phase. If certain processes or transactions are dropped from
scope, there may be less data to convert. However, if new transactions are added midway
through the project, it may be necessary to plan for additional data requirements.
In a traditional multiyear implementation this is less of a problem. The implementation
team would go through a formal design process and produce a system design
that would then be frozen as configuration and testing were begun. However, in
a rapid implementation a lot of these activities happen in parallel and require close
communication and coordination between team members.
Much of the data for the new system will come from existing systems. However,
it is common to find certain items of data that are needed that do not even exist in the
legacy systems. As a result, some of the data will have to be created for use in the
new system. Data creation is a task better delegated to the eventual system users than
the project team members. However, it needs to be managed as part of the overall
project.
While most of the data to be converted will come from legacy systems, it is not
uncommon to find some of this data in manual systems and other ancillary storage
areas. Some key organization data is in an Access database or Excel spreadsheet on
someone's desktop computer. Just finding out where the information comes from to
support the current processes is sometimes a challenge. Often the same data is stored
in multiple places, for example, in the legacy system and in an Excel spreadsheet.
When this happens, the team needs to determine which source has the most accurate
and complete data.
This mapping activity is an ongoing task throughout the implementation project
and requires close coordination between the IS personnel who know the record layouts
in the legacy systems and the process analysts who are determining which parts
of the standard package will be implemented.
Once the data is found, the real work begins. Data integrity is often a big problem
that requires a large number of people to be involved in cleanup activities. Data integrity
problems are not caused by the implementation project; but they become more
visible during a system implementation and must be resolved before the data is
loaded into the new system. The old saying "garbage in, garbage out" still applies.
The old systems often have data that is redundant, inaccurate, inconsistent, and incomplete.
There are many examples of the symptoms: the same customers or vendors
are listed multiple times in the legacy system files with different spellings and numbers.
The materials and quantities in bills of materials are often wrong, resulting in
invalid inventory valuation and workarounds to produce goods on the shop floor. The
balances in subsidiary files do not reconcile with the control totals in the general
ledger. Thousands of items appear in the inventory files that have not been produced
or sold any time in the last 10 years.
Not all the data in the old system has to be converted to the new system. In a rapid
implementation the team often uses various techniques (e.g., ABC analysis, 80/20
rule) to determine what really needs to be converted to be able to run the new system.
Some data can be created post-go-live to support specific transactions as they occur.
The implementation team should convert only what is really required.
Usually, people using the legacy systems clean up the data in these systems before
data conversion programs are run to transfer this information to the new system. In
situations where new data is created, this new data can be captured in Access or other
databases for automatic conversion at a later time. Consequently, cleanup can be
done in parallel with other implementation activities. This also means cleanup activities
can start early in the project. There are often surprises in this area. Therefore, the
team wants to identify problems as early as possible, while there is still time to resolve
them.
Data gets loaded into the new production databases through three primary means.
Most of the packages have data-conversion utilities that read external files that have
been organized in a prescribed format and load the data into the production databases.
In addition, the programmers from the IS department may code custom programs to
load the new data directly into the production files. Finally, it is often necessary to
load some of the data manually, using the input screens of the new system. In all three
methods the data should be subject to the same edit and validation checks that would
occur if the data were loaded through regular system processes.
Once the data has been loaded into the system, someone needs to verify that the
data was transferred accurately and completely. This task is usually considered standard
procedure for financial data but it is just as important for operational data.
Various methods are used to verify the validity of the conversion activities.
Integrity checks include looking at the total number of records in each of the tables
before and after the conversion runs, calculating control totals for numerical
fields, and performing spot checks of all the fields in a sample of the records that were
converted. It is best to do some of these specific checks using the screens in the
application to make sure that the new system can read the data as stored.
The data-conversion procedures and tools should be tested as early as possible -- perhaps as early as transactions testing. Transactions testing uses small quantities of data. Some of this data could be made available using data-conversion routines.
The data-conversion process for the production database should be tested as one
of the first steps in integration testing, in the Prepare activity. The team cannot afford
to discover a few weeks before going live that they do not have all the data needed
for the new system, or any way to get data out of the old system. One of a project
manager's responsibilities in rapid implementations is to anticipate and manage the
project so there are no surprises. Data integrity and conversion is an area that must be
monitored and managed carefully or else it may jeopardize the implementation
schedule.
Some of the data may be converted ahead of the go-live date because often there
is not enough time or resources to do all the conversions at once. Because some of
the data is more static than other data, there are alternative strategies that can be used
for doing data conversion, including early conversion and synchronization. For example,
the team can convert the customer file and inventory master file weeks before
cutover as long as a control process is put in place to ensure that any customers or
items added to the legacy systems are also added to the new production databases. In
addition, any modifications to records in the legacy systems already converted also
have to be done in both systems.
Some files and items with a lot of activity (e.g., open orders) have to be converted
right before the go-live date. Therefore, these items are often converted on the weekend
before transition to the new system, while processing is frozen on the old system.
PREPARE
By the time the team gets to this activity, they are finally able to see the light at the
end of the tunnel. They have done a lot of work throughout the project to get ready
for the final push to go-live. How well they prepare for the cutover to the new system
in the final weeks of the project will often determine whether the light they see is daylight
or an approaching train. A lot of good work can be put at risk by sloppy work
right before go-live. The team needs a smooth transition to the new system.
There are several key tasks that take place in the final four to six weeks of a rapid
implementation before beginning operation with the new system:
- Integration testing
- End-user training
- Preparing the production environment
- Data conversion
- Establishing ongoing support capabilities
The team did transaction or unit testing in the Analyze-Configure-Test loop.
Therefore, they know that the system is set up so that individual transactions work.
Now is time to test the business processes end-to-end.
Extending the earlier manufacturing example, for order fulfillment the team tests
the entire process from preparing a quote, converting it into an order, reserving inventory,
generating a production order, issuing materials to production, recording
completed production and scrap, shipping the order, preparing an invoice, recognizing
revenue and the corresponding receivable from the customer, and applying the
payment received.
Depending on the implementation scope, there may be 2 to 10 processes to test for
completeness and integration in this activity. For example, after testing the fulfillment
transactions the team may next test the financial close process or payroll processing.
Then they may turn to production scheduling or procurement.
Integration testing takes time because of the number of different processes to thoroughly
test and the number of steps in each process. It requires a cross-functional
team to verify the effects throughout the system. Like transaction testing, it requires
preparation of a test plan, test data, and expected results. And, like any testing activity,
integration testing will uncover errors that need to be researched, fixed (perhaps
by table or parameter changes), and then retested.
Managing the testing process is challenging because of the number of people involved,
the complexity of the tests that address integration across the entire system,
and the need for strict configuration and version control. Integration testing, as well
as the other activities in Prepare, occurs at the end of the project as budgets and time
are running out. This is an area of the project where there is a lot of pressure to take
shortcuts and not follow a thorough test plan. These pressures must be resisted. No
one benefits from having a system go into production that does not work properly.
Some members of the implementation team can complete the preparation of enduser
training materials while others conduct the integration tests. However, hands-on
training should not occur until the system correctly processes transactions. The team
will lose a lot of credibility and create anxiety throughout the organization if the new
system does not work properly in the training sessions.
End-user training should leverage the user procedures and system documentation
that have been developed by the team. These are the aids the users should refer to as
they perform their jobs; so, they should be introduced and used in the training
courses. These procedures walk the users through the steps for doing their jobs with
the new system. Using this approach, training becomes a simulation of real transaction
processing using the job aids and a new system.
Depending on the number of users to be trained and the number of times each
training session must be offered, it is not unusual for end-user training to take two to
four weeks. Users may receive from several days to a week of training on the details
of how to do their work using the new system. All users should begin their training
with a system overview that includes practice navigating around the package.
End-user training cannot be scheduled too early in the project or people will forget
what they learned before they get to apply it. However, if it is started too late,
there will not be enough time to do sufficient training. Since end users still have their
regular jobs to do while attending training on the new system, scheduling the training
to meet project and job demands is a complicated administrative task.
Providing training of high quality is important to ensure people feel confident that
they know how to do their jobs with the new system. It is an investment in the organization's
people and a prerequisite to achieving the benefits from the system.
Training also provides an opportunity to sell the new system to the users. Therefore,
it is a key change management tool.
While integration testing and end-user training are going on, the IS department
is working hard to finish setting up the production environment for the new system.
In some cases, this requires purchasing and installing new hardware to handle the
large number of users and high volume of transactions that will be processed daily
after cutover. In other cases, the new system will run on the existing technical infrastructure.
In either case, it is necessary to stress-test the system to ensure that it
can handle the production load.
Another time-consuming task for IS team members is setting up security authorizations
for all the users of the new system. Users should have access to all the parts
of the system required to do their jobs, but only to those for which they are authorized.
This task goes quicker if it is possible to create role profiles that define authorizations
for a particular job. These profiles can then be cloned to develop access lists
for all the users doing the same tasks. The internal audit department should be actively
involved in this activity and all others involving internal control considerations.
By the time the team has reached these last weeks of the project, all data-conversion
procedures and tools should have been thoroughly tested. As the team approaches
go-live, it must run the data-conversion procedures and programs to populate
the production databases. Throughout this process, audit trails are produced to
provide information to research problems and document the conversion results.
Error reports are produced throughout the conversion process. These reports
show what information was not accepted by the new system. There are a number
of reasons for posting failures. The file sizes on the new system may have been set
too small. In addition, some of the data may not have been of the quality required
by the new system. This converted data should be put through the same edits and
validations that occur during normal transaction processing on the system. If the
legacy data cleanup efforts were not completed in time, follow-up activities will
have to be scheduled to clear data exceptions and complete the data-conversion
process.
Finally, before go-live, the team needs to activate help desk and systems support
functions to help users and managers with problems once they start processing on the
new system. The project team members will be around for a short period after go-live
to assist in this effort. But a permanent function should be established for the ongoing
support and maintenance of the system.
This support function may include a help desk, support resources in the IS department,
and power users in functional departments who can answer questions and
resolve problems people will have in the production environment. Knowledge transfer
to this support group should take place throughout the project. Often, some of the
team members take on support roles after the implementation project is finished.
GO-LIVE
Go-live is a hectic and confusing time. People have been trained on the new system
but now they have to use it in their daily jobs. Often, they find out that they did not
understand how to use the new system as well as they thought. The organization has
real customer orders coming in and needs to keep customers happy and ship goods
on time -- even as it works through the inevitable problems that will occur in the transition
to any new system.
The organization should expect problems for a period of time following the
cutover. This time period varies from a few days to a few months, depending on the
situation. In spite of all the preparation and contingency planning that was done,
problems will occur. Systems are developed by and used by human beings who, despite
the best of intentions, make errors. So things will happen that were not expected
and tasks will be done differently than planned.
The limited scope of a rapid implementation may help to minimize the amount of
disruption that occurs. However, the organization has had less time to get ready for
the new system with a rapid approach. Experience from a large number of package
implementations has shown that all organizations should expect a performance dip
immediately following the cutover to the new system.
People need a lot of support in the days immediately after beginning to use a new
system. Help desk personnel will be available to provide support. However, during
the first weeks after go-live, there need to be additional resources assigned to diagnose
and solve problems that surface. The project team members provide a lot of this
additional support. They often engage in triage activities to identify the biggest problems
and ensure that adequate priorities and resources are available to solve them.
During this time people will be tempted to fall back to their old ways of doing
things. Therefore, one of the key post-go-live tasks is to remove the old systems and
tools and force the users to rely on the new system. This may mean removing access
to legacy systems, Excel spreadsheets, and other applications running on the LAN or
individual workstations. Management and the project team need to enforce use of the
new system.
Some people may try to sabotage the new system and its processes. They may believe
that if the new way fails, management will go back to the old way of doing
things. Again, these activities and this attitude should be nipped in the bud. Management
should show its support and commitment to the new system. This requires
visibility and communication in the key days after processing has begun with the new
system.
A key, and often missed, opportunity during the final days of the implementation
is to capture the lessons learned from the project. The organization should be trying
to develop expertise in making rapid changes to business processes and the technologies
that support them. If they want the next rapid implementation project to be better, the organization should learn from the mistakes and successes of its prior projects.
A postmortem should take a realistic looks at the project while the information is
fresh in people's minds. What went well and should be reproduced in the next rapid
implementation project? What did not and therefore requires a different approach in
future projects? Given 20/20 hindsight, what could the project sponsor, project manager,
and the team have done differently? These items should be discussed in detail,
maybe with the same group that attended the kickoff meeting. This could be considered
a project close meeting.
This meeting should be followed by a celebration dinner or event for the project.
Participating in a rapid implementation project requires a lot of hard work and places
a lot of stress on all the project team members. If the project was successful, you can
bet that a lot of people made a lot of sacrifices to make that happen.
What the team has accomplished is important to the organization and should be
recognized and rewarded as such. Top management should make its support and appreciation
for these efforts visible to the team and the rest of the organization. This is
especially important if they want others to sign up for these projects in the future.
After the project is completed, management should make good on any commitments
made to the team members before the project began. And immediately following
the celebration, planning should begin for the next rapid implementation project.
No organization is ever finished adapting its processes and systems to changing
business requirements.
IMPROVE
In order to do rapid implementations, trade-offs must be made. The benefits from a
rapid implementation approach do not come without costs. The assumption is that before
management chose a rapid implementation approach for the system that just
went live, they deemed the trade-offs acceptable. These trade-offs result from several
characteristics required to make this approach successful:
- Time boxing
- Aggressive scope management
- Package-driven process design
- No customizations
As will be discussed in more detail in Chapter 4, many of the activities in a rapid
implementation project are time boxed. This means that the team does the best they
can on specific activities -- within some pretty strict time and resources constraints.
Priority was given to making business process and system changes in a short period of time rather than necessarily dotting all the i's and crossing all the t's. These projects are done rapidly in order to accelerate the benefits and change business processes
to respond to significant, often short-term business needs.
However, taking this approach does not mean that there is not a case for going
back and enhancing the work that was done, at some later time. Examples of things
that may be done in the future include preparing additional procedures for handling
exception situations, implementing additional processes, and developing and delivering
additional training in areas where people are having problems.
The scope of the rapid implementation project is aggressively managed. The
80/20 rule is the guideline for establishing priorities. The implementation team tries
to identify and implement the 20 percent of the business processes and systems functionality
that provide 80 percent of the benefits. That is the right thing to do if the
organization wants to maximize the return on the implementation investment. But
again, there may be merit in implementing some of the remaining 80 percent of functionality
in a future project.
What additional functionality should be implemented may not be clear at this
point in the system life cycle. Sometimes it is best to require the users to make do
with the system they have before deciding what additional functionality is really required.
A good example is making them use the standard reports from the package
for a period of time before deciding that customized reports are needed. The fact is
that users will be in a better position to determine priorities for future enhancements
to a system once they have experience working with the processes that were implemented.
One of the design guidelines for rapid implementation is that it is better to have
the organization change its business processes to conform to the way that is supported
by the package than to change the package. It is very expensive (time and money) to
make modifications to the vendor's software to support the current way that processes
are performed. Even worse, these programming changes will have to be
reapplied and tested every time the organization implements newer versions of the
vendor's package.
Many organizations have some pretty bad business processes that users want to
replicate in any new system. Also, if the organization does the same process three different
ways in its three locations, managers and users want all three alternatives supported
by the software. So, there are good reasons not to automatically implement the
existing practices with the new software.
Many best practices are incorporated in the design of the standard packages. These
practices leverage the benefits of real-time, integrated systems with enhanced functionality
that was often never available in an organization's legacy systems. Also,
there are a lot of benefits from standardizing processes within an organization (i.e.,
deciding on the best way to do things and having everyone do it that way, without exception).
Therefore, in many cases, conforming to the way the package does things
is a good strategy.
A rapid implementation strategy generally does not support modification of the
vendor's code. The project team uses the plain-vanilla version of the vendor's software
and then tailors the package to the needs of the organization through the use of
parameter tables and reporting tools.
However, there are going to be situations where there is a good reason to add bolton
functionality to do things not supported by the package. Bolt-on functionality is
interfaced to the vendor's system and usually does not involve modifying the vendor's
code.
This new functionality may be provided by another vendor's package or may be
custom-developed by the organization's IS department, with or without the assistance
of consultants. As long as there is a valid business case for these enhancements,
there is nothing in the rapid implementation approach that says that these changes
cannot be made in a future implementation phase. However, before jumping into
these changes, the organization should give the system, as implemented, a chance.
Often, after spending some time using the new system, the users will come up with
ways to handle difficult requirements using the existing capabilities of the package.
A key message from the roadmap is that the initial rapid implementation project
is the first phase in the life cycle of the new system. The organization and its customers
and suppliers will be constantly changing. Business strategies, models, processes,
and organizational structure will change. Therefore, the system will have to
continuously change to meet these changing requirements.
Consequently, there will be many opportunities to change and improve the system
that has been implemented. The organization should establish a process to identify
and prioritize these changes and, when appropriate, begin the Commit activity all
over again.
