To run a smooth supply chain, manufacturers need to keep track of many types of data, including order capacity, bills of resources and production schedules. In this book chapter excerpt, find out how Oracle supply chain management (SCM) software can help with manufacturing capacity planning and production scheduling processes and get tips for using Oracle SCM software.
Table of contents:
Oracle E-Business Suite Manufacturing and Supply Chain Management
Manufacturing capacity planning and production scheduling process
Manufacturing tips for Kanban production control and BOM management
Capacity Planning
Oracle provides two types of capacity planning within its planning products: Rough
Cut Capacity Planning (RCCP) for evaluating the high-level capacity requirements
of a master schedule and Capacity Requirements Planning (CRP) for evaluating the
detailed capacity requirements of an MRP (or ASCP) plan. Both types of capacity
planning compare the available capacity with the calculated requirements. Available
capacity comes from your resource definitions, as described in Chapter 4; what
differentiates CRP from RCCP is the method of calculating the resource requirements.
Capacity Requirements Planning (CRP)
CRP calculates required capacity from the routings used to build your products. It
is always run as part of running an MRP (or DRP) plan, since it needs to know the
planned orders for its calculation.
In calculating resource requirements, CRP uses the primary routing for planned
orders, but will use alternate routings if they have been specified for existing jobs. It
recognizes modifications you have made to WIP resources (for example, specifying
the use of an alternate resource). Because it is run as part of MRP, it benefits from the
netting logic inherent in planning -- if your on-hand quantities don't require planning
of new replenishment orders, you won't generate capacity requirements. And if jobs
on the shop floor are partially completed, CRP recognizes which resources have
already been used and only plans requirements for the resources that remain.
Rough Cut Capacity Planning (RCCP)
RCCP lets you check your master schedule against critical resources that you identify in
a bill of resources. RCCP can be used to evaluate either master production or master
demand schedules. In a manufacturing environment, it is more typical to use RCCP to
evaluate production schedules because the constraints are most often manufacturing
resources. In a distribution environment (or for a quick check on distribution-related
resources), you can use RCCP to evaluate master demand schedules.
What makes rough cut rough? Since it does not use detailed routings, it is
inherently less detailed. Though it might seem obvious, a hidden implication is in
the requirements for subassemblies. Because RCCP does not depend on the netting
and explosion logic of MRP, it may show resource requirements for subassemblies even if a subsequent MRP plan will find that there are no net requirements because
of on-hand quantities. And there is no visibility to the progress of WIP jobs.
Bills of Resource RCCP calculates resource requirements simply by multiplying
the master schedule quantity by the resource requirements expressed in a bill of
resources that you define for the master scheduled item. In a manufacturing
environment, you can construct a bill of resources by rolling up the routings; this
process is called a bill of resource load. The result might be considered a kind of
"aggregate routing" for the item; it lists all the resources you need to manufacture
the master scheduled item and all its subassemblies. You can then modify the bill
of resources by deleting noncritical resources or by adding resources that are not
normally part of your routings -- shipping capacity, for example.
Strictly speaking, a bill of resources is a listing of the resources you want to
evaluate for a single item. But, to be useful, any evaluation of capacity must look
at all the demands placed on your resources. It doesn't do much good to know that
item A requires 20 hours of a resource, unless you also know the demands placed
by items B and C -- it's the total resource requirements that you must compare to the
resource availability. For this reason, bills of resource are grouped into a bill of resource
set; when you evaluate rough cut capacity planning, you must specify which bill of
resource set you want to use to calculate resource requirements. Like so many objects
in the Oracle Applications database you can have multiple bill of resource sets; this
might be useful for simulations, or to evaluate distribution resources against your
demand schedules and manufacturing resources against your production schedules.
Once you have defined a bill of resource set, you can view your rough-cut
capacity plans on demand; the calculations are done when you perform the inquiry
or run the report.
Use the Load Bill of Resource concurrent program to calculate bills of resource
from your routings. Parameters include
- The bill of resource set you are loading.
- Whether you want to preserve any manual additions or modifications you
may have made to the bill of resources, if it already exists.
- A resource group, to limit the creation of the bills of resource to items within
a specific resource group. (Resource groups are discussed in Chapter 4.)
- Whether you want to create a bill of resource for all selected items or for
Model and Option Class items only.
- How you want to deal with other master scheduled items that might be
structured into bills of material at lower levels.
This last option, labeled Rollup MPS Items on the Parameters window, deserves

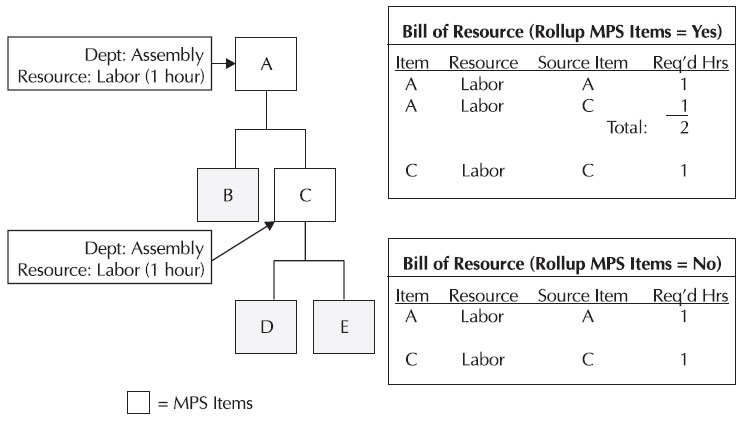

explanation. Consider the example in Figure 8-8; if the only master scheduled item
were A, you would typically want A's bill of resource to show two hours of labor --
one hour to assemble C and one more hour to put B and C together to make A. But
if C were also a master scheduled item, you would not want to roll its time up into
A's bill of resource because you could be overstating the resource requirements. If
your master schedule includes both A and C, a rough cut capacity plan would calculate
one hour per unit for C and two more hours for A. This would overstate the capacity
requirements -- one of the two required hours was already planned for by C's bill of
resource, and only one more hour of labor is needed to assemble product A.
You avoid this problem by setting the parameter Rollup MPS Items to No; this
"breaks" the rollup process at each master scheduled item and ensures that a bill
of resources does not contain resources that were already accounted for on other
master scheduled items lower in the bill of material. Note that the parameter does
default to Yes. While it's possible to construct a scenario where this could make
sense (e.g., you plan to do rough cut capacity planning only against your top-level
items), it would be inappropriate if you plan to do rough cut planning for all of your
master scheduled items. Consider this carefully when loading bills of resources.
You can also build bills of resource "from scratch" by listing the resources you
want to check in your RCCP plan. If you define bills of resource manually in a manufacturing environment, you may want to include the critical resources you need
to build subassemblies of the master scheduled item.
A bill of resource for an item consists of one or more rows of data that specifies
the following attributes for each resource you list. On the Main tab, enter the following
information:
- Department or Production Line and Resource critical to the production
or distribution of the item These are often the same departments and
resources you use in your production routings, but you can also define
other resources that might not traditionally be part of a routing. For example,
if shipping capacity is critical to your business planning, you could define
it as a resource within a department and use RCCP for a quick evaluation.
The key thing to remember is that you must define these resources and
assign them to departments, defining their available capacity just as if you
were going to use them in a routing. This process is described in Chapter 4.
- Source Item That is, the item responsible for the demand. In a rolled-up
bill of resources, this will be the item whose routing contributed the resource
usage, either a subassembly or the item itself.
- Setback Days The number of days prior to the schedule date that the
resource is required. For example, if the resource is required two days
prior to the schedule date of the item, enter 2.
- Usage Quantity The exploded quantity from the bill of material. This is
the quantity of the source item required to make the item whose bill of
resource you are defining; if the source item is the item itself, this quantity
will be 1. Note that this is not the quantity of the resource required; you
enter that information on the Discrete Resource tab.
On the Discrete Resource tab, enter the following information:
- Required Hours and Basis Type Just as on a routing, a Lot basis means
that the resource hours are required only once per lot (in this case, master
schedule entry); for example, a setup. An Item basis means that the required
hours are need for each unit of the item on your master schedule.
- Op Seq The operation sequence where the resource is used. This will be
populated for you by the bill of resource rollup; if you are defining (or
modifying) a bill of resource manually, you may specify the correct
operation or enter 1.
The bottom of the form displays the source of the entry: Rollup means that the
entry is the result of a routing rollup. Manual addition or Manual update indicates that you have created or modified this entry manually; this distinction allows you to
re-roll routings and optionally preserve manual modifications to your bills of resources.
Planning for Engineering Changes
A key element of planning is the ability to recognize anticipated bill of material and
routing changes. This allows you to phase in changes to the products you manufacture
and have planning react appropriately -- planning will stop generating orders for
the obsolete components or resources and begin ordering the new components
or resources.
Effectivity Dates
Both bills of materials and routings use effectivity dates, indicating when a component
or routing operation begins to be effective, and optionally when the component or
operation is disabled. Effectivity is determined by the start date of a planned order;
planning (and WIP, if you manually create a job or schedule) will select only those
components that are effective on the date the job is scheduled to start.
The effective date, labeled "From," defaults to the current date when you create
a bill or routing; you can select a future date if the element is not yet effective. You
cannot select a date in the past. If the ending date, labeled "To," is left blank, it indicates
that there is no planned end to the effectivity of the component or operation.
Note that the To date is a disable date, the date (and time) that the component
or operation is no longer used. This is important if you are replacing one component
with another; you set the starting (From) date of the new component equal to the disable
(To) date of the old component so that the new component becomes effective at the
same time that the old component is discontinued. Unlike some systems that might
term the end date an Effective Thru date, if you were to disable a component on the
15th, for example, but not start the replacement until the 16th, a job or planned order
that started on the 15th would contain neither component.
When you're setting the effective dates for a new component, it's helpful to
know its Total cumulative lead time. If you plan to add a component within its
cumulative lead time, you might have to expedite orders in order to obtain the
component in time.
Effective dates can be entered manually on bills or routings; effective dates on
bills of material can also be maintained with Engineering Change Orders (ECOs).
With Release 11i.5, you can also use ECOs to modify routings.
Engineering Change Orders (ECOs)
ECOs provide a more controlled environment for maintaining effectivity dates than
the simple bill of material maintenance process. ECOs (described in Chapter 5) let you group multiple changes under a single control number. With an ECO, you set an
effective date for all of the changes you want to make to an individual bill of material;
this eliminates any possibility of "gaps" if you define a replacement component and
lets you keep multiple component changes in synch with one another. ECOs allow
the system to calculate the effectivity dates for a set of changes based on using up a
component on a bill (or using up the assembly itself). ECOs let you control whether
a set of changes is visible to the planning applications. And ECOs can base the schedule
date of a change on the date on which an assembly or component is scheduled to
be used up.
Schedule Date Changes
As you change effectivity dates, planning will replan accordingly. Moving a schedule
date in (scheduling the change to occur earlier than originally planned) can result in
expedite suggestions from planning; moving a date out could result in shortages of
the old component, particularly if you have deactivated it.
If a pending change is driven by the use-up of the assembly itself, the schedule
date of the change will be updated automatically if MRP calculates a new use-up
date for the assembly. If the change is driven by the use-up of a component of the
assembly, MRP will trigger the ECO Use Up Alert to notify the appropriate planner.
NOTE
At present, Use-Up planning is only integrated with
MRP, not with Advanced Supply Chain planning.
Discrete versus Repetitive
Planning Logic
Oracle Applications allow you to plan for both discrete and repetitive production
methods in a single plan. Discrete production involves recording production against
discrete jobs, sometimes called work orders or production orders. Discrete jobs
represent production of a specific quantity of an item, completed on a specific date.
Repetitive production records production against repetitive schedules, which represent a
continuous rate production for a period of time. While much of the planning logic is
the same, there are a few key differences between discrete and repetitive production
that necessitate differences in the planning logic.
NOTE
Don't confuse repetitive production with flow
manufacturing. Repetitive production is designed for
relatively high volume, continuous production of
standard items. Flow manufacturing is designed for
rapid production of individual items, even customconfigured
products, at varying rates of production.
Repetitive Production Concepts
A repetitive schedule represents continuous production over a period of time; it
models an ongoing rate of production and ongoing consumption of components.
Compare this with a discrete job that represents production of a specific quantity of
a product on a specific date and models an individual requirement date for each
component. Whereas a discrete job has a start date and a completion date, a

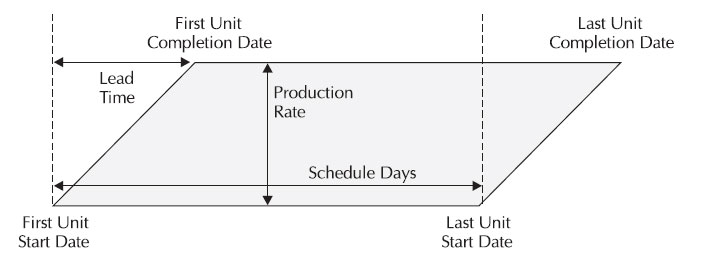

repetitive schedule is defined by four dates:
- First unit start The date that the first unit is started on a production line
- First unit completion The date that the first unit is completed on the end
of the production line
- Last unit start The date the last unit on the schedule starts down the
production line
- Last unit completion The date that the last unit is completed
These dates are represented in the following diagram:
Discrete jobs have a total job quantity to be completed on a specific date. Each
component on a discrete job is required on a specific date. Repetitive schedules, by
contrast, represent a rate of production for a period of time (defined by the first and
last unit completion dates). On a repetitive schedule, products are produced and
components are required continuously over the duration of the schedule.
The nature of repetitive production requires slightly different planning logic than
that described earlier; the following pages discuss differences between planning for
discrete production and repetitive schedules.
Repetitive Planning Logic
The objective of repetitive planning is to calculate a smooth rate of production for a
period of time. When planning repetitive production, the process calculates the rate
of production by taking the average daily demand within user-defined buckets. This
process requires some unique planning logic and uses some terminology that has
not been discussed previously.
Planning Periods
You establish planning periods on the Planning Parameters form for each inventory
organization. You define an Anchor Date, which marks the start of your repetitive
planning periods. Initially, this should be the start date of the first repetitive planning
period; after that, each time you run a plan the system will roll the anchor date forward,
if necessary, to keep the anchor date consistent with the start of the first repetitive
planning period. You also define two horizons as a number of days; this breaks up
the planning horizon into three sets of periods. Within each, you define the size
of the buckets. Smaller buckets are often used in the first set of periods, so that
repetitive planning is more reactive to changes in demands, while larger buckets in
the later sets of periods allow planning to generate smoother production plans.
When you define repetitive planning periods, you can choose whether to use
workdays or calendar days. Though it seems counterintuitive, it is generally advisable
to use calendar days to determine the length of your planning periods. Using calendar
days lets you ensure that your planning periods always start on the same day of the

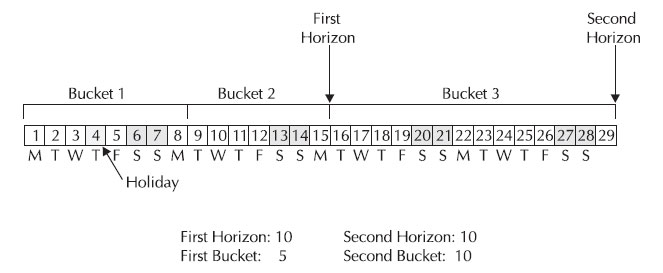

week, regardless of holidays or other non-work days. Consider Figure 8-9; if you
define your repetitive periods to start on a Monday and define each period as five
work days in length, the first scheduled non-work day will shift the next period to
start on Tuesday.

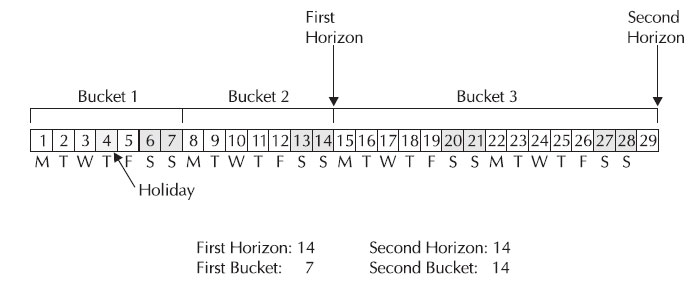

If instead you define your repetitive periods as seven calendar days long, each
period will start on the same day of the week regardless of intervening holidays, as
shown in Figure 8-10. Calculation of average daily demand will always use the number
of work days within a period, even if the length of that period was determined by
using calendar days.
Average Daily Demand
Consider the example in Figure 8-11. This example shows a weekly planning
period, with demand of 40 on Wednesday of that week and demand of 10 on
Friday. Since there are five working days in that weekly bucket, the average daily
demand is 10 (50/5); consequently, planning will suggest a repetitive schedule with
a daily rate of 10. Note, however, that this will not satisfy the demand of 40 on
Wednesday; if you produce 10 per day, you will only have produced 30 by the end
of the day on Wednesday and will not satisfy the total demand. To satisfy the demand,
you may need to produce at a different rate than suggested, consider reducing the
size of your repetitive planning buckets, or even consider if repetitive planning and
production are suitable for a product with such an erratic demand pattern.
| Day |
1 |
2 |
3 |
4 |
5 |
| Demand |
|
|
40 |
|
10 |
| Production Rate |
10 |
10 |
10 |
10 |
10 |
FIGURE 8-11. Average daily demand
An implication of this planning method is that demand is generated daily for
the components of a repetitive schedule. This generally results in a large number
of discrete demands. If you are not prepared to respond to these individually, you
should consider adding order modifiers, for example, a minimum order quantity
or fixed days supply.
Recognition of Existing Schedules
Perhaps the most unconventional aspect of repetitive planning is that it does not
recognize, nor suggest changes to, any existing schedules. It always suggests new
schedules. In part, this is because repetitive schedules have no identifying number
(like a discrete job); they are identified by the rate and the four key dates. Suggesting
a change to any of these parameters, therefore, means suggesting a new schedule.
Thus, repetitive planning does not need to know the existing schedules; its job is to
suggest the right rate of production.
Another implication of the fact that repetitive planning does not consider existing
schedules is that any changes you made to the component requirements of a
repetitive schedule are not considered in planning. If you have made a component
substitution, for example, the planning process does not recognize it. Thus, you
must carefully monitor the availability of substitute material (or excess plans for the
original material). While this may appear problematic, remember that repetitive
production is designed for high-volume production of standard items; if you are
making frequent changes to component requirements, the product may not be a
good candidate for repetitive manufacturing.
Treatment of Order Modifiers
Like discrete planning, repetitive planning uses order modifiers -- minimum and
maximum order quantities and fixed order quantity. While these are the same
modifiers that discrete planning uses, they are interpreted as modifiers to the daily
rate, not to the total schedule quantity. Keep this in mind if you use modifiers on
repetitively planned items, or you can dramatically inflate your schedule rates.
NOTE
One exception to the use of order modifiers is the
Fixed Days Supply modifier. Because repetitive
planning inherently plans for a fixed number of
days (as determined by your repetitive planning
buckets), the Fixed Days Supply modifier is simply
ignored for repetitive items.
Planning Controls
To allow you to build stability into repetitive plans, Oracle provides several controls
that determine the maximum increase or decrease in repetitive schedules at different
points in time. Oracle also allows you to specify how much overproduction you will
tolerate, in order to reduce suggested changes to production rates.
First, within an item's lead time, planning will not suggest any new repetitive
schedules. This reflects the fact that it is often difficult or impossible to change the
production rate once an item has started down the assembly line.
Second, within an item's planning time fence, Oracle makes use of the item
attributes Acceptable rate increase percent and Acceptable rate decrease percent.
These attributes let you specify how much of a change is allowed within the planning
time fence. These percentages are applied to the current rate of production and
determine the maximum and minimum rates that planning will suggest for new
schedules. For example, if the current production rate is 100 units per day, an
Acceptable rate increase of 10 percent means that planning cannot suggest a
new rate greater than 110 per day within the planning time fence. Similarly, an
Acceptable rate decrease of 10 percent means that planning could not suggest a
rate lower than 90 per day. Outside of the planning time fence, however, planning
is free to suggest whatever rate is required.
Note that zeros and nulls are treated very differently in these attributes. A zero
means the acceptable increase or decrease is indeed zero; no rate changes are allowed.
Leaving the attribute blank (null) implies that there is no limit on the acceptable
increase or decrease; planning can make whatever suggestions it wants.
To dampen minor fluctuations in repetitive schedules, planning uses another
item attribute, Acceptable overrun percent. This is the amount that the current daily
rate may exceed the optimal rate before planning will suggest a new rate. In other
words, it is the rate of overproduction that is acceptable in order to avoid minor
changes in scheduled rates. The overrun percent is applied to the optimal production
rate, and the result is compared to the current aggregate rate. For example, if the
optimal production rate is 100 units per day, and the Acceptable overrun percent
is 10 percent, your current production rate could be as high as 110 per day before
planning would suggest a new schedule with a lower rate.
Repetitive Schedule Allocation
Repetitive planning begins with the calculation of the total production required; this
may be accomplished on multiple production lines, so the total required is referred
to as the aggregate repetitive schedule. Once the aggregate rate of production is known,
planning will allocate production across all the lines designated for the product.
When you define production lines for an item, you specify the maximum rate the
line can produce and assign a priority to that line and item combination; planning
uses these rates and priorities to allocate production across lines.
The allocation process first attempts to assign production to the highest priority
line (lowest number) for the item. Allocation will load the first line to its stated
capacity, then load the second line to its capacity, and so on. If there is not enough
capacity across all the designated lines for an item, allocation will load the excess
production onto the first line. Note that while allocation will attempt to respect the
maximum stated capacity of a line for an item, it does not consider the load placed
by other items that may also be scheduled on the line. Also keep in mind that it will
overload the primary line for an item, if necessary.
Repetitive Schedule Implementation
You can implement repetitive schedules from the Planner Workbench in much the
same way that you implement discrete jobs; simply select the job or schedule for
release, and initiate the load process from the Planner Workbench. This initiates the
WIP Job/Schedule Interface program to load the job or schedule into WIP. But while
a discrete job may be loaded in either a released or unreleased status, repetitive
schedules are always loaded with a status of Pending -- Mass Loaded.
This status avoids a restriction in WIP on the existence of overlapping repetitive
schedules. WIP will not allow schedules for the same item on the same line to
overlap, unless the schedules have a status of Cancelled or Pending -- Mass Loaded.
As mentioned earlier, planning always suggests the needed schedule and does not
suggest changes to existing schedules. If you have already implemented a repetitive
schedule for the same item, line, and time period, a new schedule would overlap.
Thus, schedules implemented from the Planner Workbench always carry the status
of Pending --Mass Loaded. You must release these schedules in WIP, respecting the
restriction on overlapping schedules, before you can report production against the
new schedule.
When you release a repetitive schedule, you have the opportunity of closing or
canceling existing schedules; this lets you avoid overlapping schedules. Alternatively,
you can simply modify the rate or dates of the existing schedule based on the
suggestions of the new schedule; then you can cancel the new schedule. This is
preferable if you have issued material or charged labor to the existing schedule, as
it avoids misleading variances. The use of the Planner Workbench is discussed in detail in Chapter 11 and 12; repetitive production is described in more depth in
Chapter 16.
Configuring Repetitive Planning
Repetitive planning requires the same setup as discrete planning. In addition, because
of its unique requirements, it requires the following:
- Define production lines on the Production Lines form.
- Associate items and production lines using the Repetitive Line/Assembly
Associations form.
- Define repetitive planning buckets on the Planning Parameters form.
- Designate the desired items to use repetitive planning logic on the Master
Items or Organization Items forms.
- Set repetitive planning controls, also on the Master Items or Organization
Items forms.
