Implementing strong Kanban manufacturing techniques can greatly improve supply chain efficiency and productivity. In this book chapter excerpt, discover how Oracle supply chain management (SCM) software can help with Kanban in manufacturing - including Kanban setup and production control - and find out how Oracle SCM software can improve bill of materials (BOM) management.
Table of contents:
Oracle E-Business Suite Manufacturing and Supply Chain Management
Manufacturing capacity planning and production scheduling process
Manufacturing tips for Kanban production control and BOM management
Kanban Planning
Another type of planning that Oracle Applications provides is kanban planning,
part of Oracle's support for Flow Manufacturing techniques. As noted in Chapter 1,
kanban is a Japanese word that suggests "sign" or "signal." From a manufacturing
perspective, a kanban is a visual indicator -- sometimes a card, sometimes an empty
bin or rack -- that triggers replenishment of an item. The intent is to streamline the
manufacturing and procurement process; rather than relying on a computer
simulation to suggest when to order, kanban replenishment triggers orders based
on an operator actually signaling that more material is needed.
While kanban replenishment does not rely on MRP planning to launch the
replenishment orders, effective use of kanbans does require appropriate sizing. If a
kanban is too small, you might run out of material before it is replenished; if it is too
big, you carry excess inventory. Oracle provides a kanban planner to size kanbans,
and to resize them when necessary. In addition, though kanbans eliminate the
launching of orders from MRP, MRP planning can still be valuable -- it can provide
calculation of usage over time, which can be useful in supplier negotiations or
when deciding to expand manufacturing capacity.
Kanban Setup
You designate items as kanban-controlled through the item attribute Release Time
Fence. Setting this attribute to Kanban Item (Do Not Release) prevents you from
releasing orders from the Planner Workbench.
For the purposes of planning, kanban setup involves defining pull sequences,
which specify the source of replenishment and planning parameters for kanbanplanned
items. For each item under kanban control, you define the subinventory
and optional locator that you will replenish with the kanban. Then define the source
of the replenishment (intra-org, inter-org, supplier, or production) and the appropriate
source information. For example, for an inter-org kanban, you would specify the
source organization, subinventory, and optional locator from which the material
will be pulled.
The factors that control planning are the planning method, lead time, and lot
sizing information for the specific kanban location. There are three planning methods:
- Kanban size With this method, you specify the number of cards or
kanbans you desire, and the planning process calculates the size of those
kanbans, i.e., how much material must be replenished each time the
kanban is signaled. For example, if you elect to employ a simple "two-bin"
replenishment system, you would specify 2 as the number of kanbans;
planning would calculate how much material is required in each bin to
keep the line flowing smoothly and efficiently.
- Number of cards Using this method, you specify the size of the kanban,
and planning calculates the number of kanbans you need. For example,
your kanban might be a rack or tote capable of holding a fixed amount of
material, or you might determine the container size that an operator could
move safely without assistance; planning determines how many of those
containers you need.
- Do not calculate With this method, you size your kanbans manually. This
method excludes an item from kanban planning, while still letting you use
the kanban to signal replenishment.
In addition, there are lead times and lot sizes defined for each pull sequence
that affect the planning process:
- Minimum order quantity This is defaulted from the item, but you can
override for a specific pull sequence.
- Lead time This is the lead time to replenish one kanban from its source.
- Lot multiplier Use this if it makes sense to replenish in fixed multiples --
for example, if the item has a natural lot size.
- Allocation percent This represents the distribution of an item's demand
across multiple locations.
- Safety stock days The number of days of safety stock you want to maintain.
Additional detail on kanban setup is provided in Chapter 15.
Kanban Calculations
Kanban planning calculates the required number or size of kanbans, based on the
planning method you specified for each pull sequence. Basically, the process looks
at the average daily demand you supply and the planning parameters from each pull
sequence and determines how much material or how many kanbans are needed to
supply that demand. The details of the calculation program are described in detail
in the Oracle Master Scheduling/MRP and Oracle Supply Chain Planning User's
Guide, part of the Oracle documentation library provided with the software.
Average Daily Demand
A key to kanban planning is the calculation of average daily demand. When you
define a kanban plan, you specify the source of demand -- you can use a forecast, a
master schedule (MDS or MPS), or actual production. For your initial kanban plan,
you might want to use the same forecast or master schedule used for validating your
line design on the Mixed Model Map (see Chapter 7). This forecast or schedule
should be typical of the mix and volume of demand for which you are designing
your line. On an ongoing basis you should check your kanban sizes against actual
or planned production; this will give you early warning signs of changes in demand
that might require intervention -- perhaps the creation of a non-replenishable kanban
to accommodate a one-time spike or a shift in demand patterns that might require a
permanent change in your kanban sizes. This ongoing evaluation is often
overlooked in flow manufacturing environments, but the simplicity of the Kanban
Planner makes it easy to do.
Once the demand is identified, the kanban planning process performs an
explosion much like MRP to determine dependent demands for your kanban items.
The planner then applies the factors you defined in your pull sequences and uses
the calculated yields from your flow routings to determine the optimal size or
number of kanbans.
Effectivity Date Changes
It is important to note that kanban planning does not take into account effectivity
date changes. The explosion process determines average daily demand using the
effectivity date you specify when you run the plan; it does not see pending bill
of material changes. Because kanban planning uses the average daily demand,
recognizing pending bill of material changes would result in incorrect kanban
sizes. For example, if you were replacing one component with another, the average
demand would be too low for each component, and the kanbans would be sized
inappropriately.
Generating and Implementing Kanban Plans
To generate a kanban plan, you first define one or more plan names using the Kanban
Names window. The only parameter you need to specify is the source of the demand
you want to use.
Then, launch the plan on the Launch Kanban form. Specify the effectivity date to
use when exploding bills of material. You can optionally limit the plan to a range of
items or item categories, and you can enter start and cutoff dates to restrict the
demand data the plan considers.

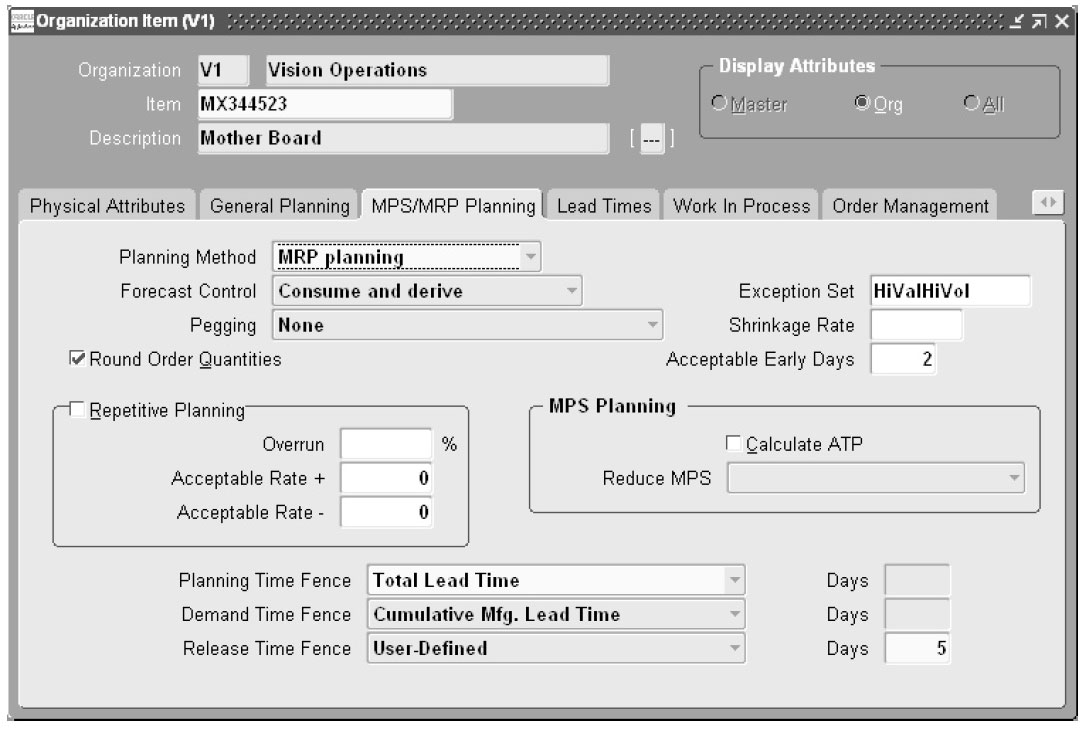

When the planning process is complete, you can view the results on the Kanban
Workbench, shown in Figure 8-12. The Details button shows the results of the
planning process and the kanban parameters upon which that plan is based. You
can view the demand used by the Kanban Planner with the Demand button.
If you want, you can rerun a portion of the kanban plan with new
parameters -- select one or more kanbans by checking the box to the left of each
row on the Details window, and modify the desired parameters. You can modify
the type of result you want to calculate (kanban size or number of cards), as well
as source information, minimum order quantity, lead time, fixed lot multiplier, and
safety stock days. For example, if you found that some kanbans were sized with odd
quantities, you could specify the appropriate fixed lot multiplier. Save your changes,
and click the Simulation Replan button. This will submit a request to run the Kanban
Planner; when the planner completes, you can requery the form to see the new results.
NOTE
Though Oracle calls this a simulation, there is no
way to simply reset the plan to its state prior to the
replan. To reset, you can either run the Kanban
Planner again or change the parameters back to
their original values and run the "simulation" again.

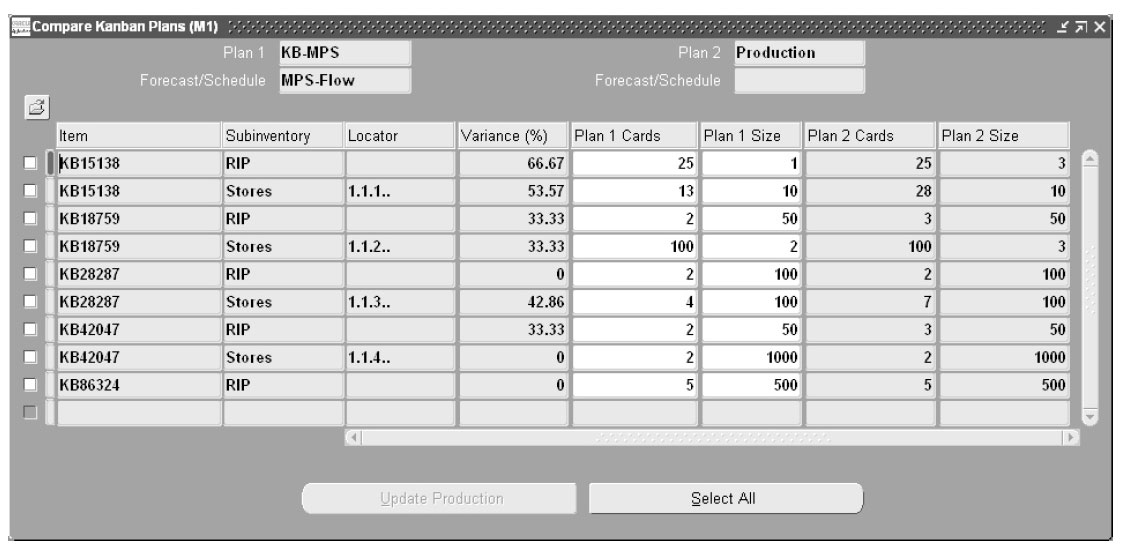

You can compare different plans, or you can compare the plan with the values
that are currently driving your production execution system. When you press the
Compare button, the Find window will ask for the name of the comparison plan; by
default, it will select Production (i.e., the current definitions from your pull sequences),
but you can select an alternative plan if you want.
TIP
To filter out trivial or nonexistent changes between
plans, consider including selection on the Variance
field in the Find window. For example, including the
criterion Variance Greater Than 0 will show only
differences between the plans.
You can implement suggested changes from either the Kanban Details or the
Compare Kanban Plans window. To implement a change, select one or more kanbans
with their selection check boxes (or use the Select All button), and click the Update
Production button. This will update your current pull sequences with the information
from the selected kanban plan. You will need to regenerate and reprint the kanban
cards as described in Chapter 15; for convenience, the Tools menu on the Kanban
Planner Workbench provides a link to the Kanban Cards form and allows you to print
selected kanbans.
Planning Parameters and Profiles
A number of parameters, profiles, and item and bill of material attributes control
the planning process. These are described in detail in the user guides for Master
Scheduling/MRP, Inventory, and Bills of Material, part of Oracle's documentation
library. A few highlights are noted here.
Planning Parameters
The Planning Parameters form lets you specify execution defaults and repetitive
planning parameters for your MPS, MRP, and DRP plans in each inventory organization. These parameters are copied to each plan you define, but you can
override them in the Plan Options window.
MRP Profiles
There are almost 100 profile options that control the execution and defaults of MRP
plans (number of workers, debug mode, etc.). Most of these can be set at the site
level, but several may be useful to set defaults for individual users. For example, the
profiles MRP: Default Forecast Name, MRP: Default Plan Name, MRP: Default Schedule
Name, and MRP: Default DRP Plan Name provide defaults for the forecasts, MRP
plans, master schedules, and DRP plans that a user will work with on various inquiry
and update forms. A default plan name will open automatically when you invoke
the appropriate form; this saves you from having to find or query the plan you want
to use (though you can override the default if desired).
Item and BOM Attributes
Much of the detail of planning is controlled by the various item and bill of material
attributes. These attributes were mentioned briefly in earlier chapters, but several
key attribute groups (corresponding to tabs on the Master Items and Organization
Items forms) are especially important to the planning process. These are described
in the following sections.

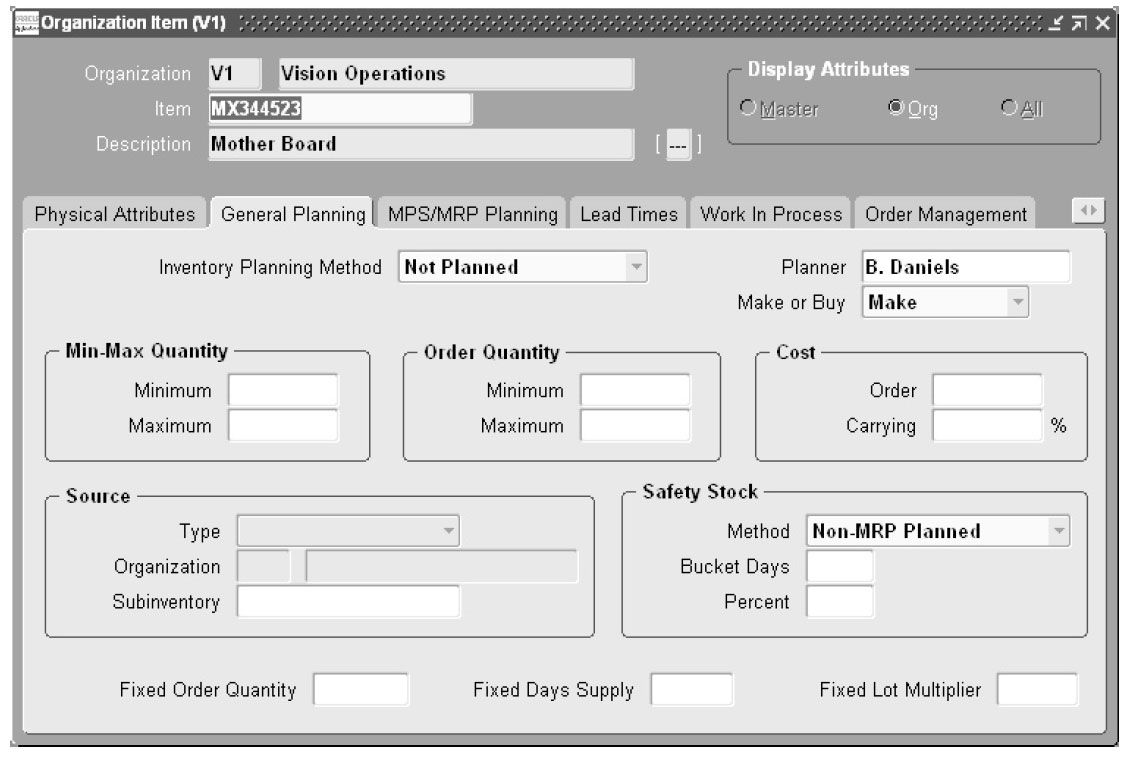

General Planning Attributes
The General Planning tab (shown in Figure 8-13) includes attributes that control
MRP and ASCP planning, as well as the simpler planning methods provided in
Oracle Inventory (Min-Max and Reorder Point Planning). Of special interest are
the following:
- Planner This field identifies the planner responsible for the item. Besides
being a mechanism to select items in the Planner Workbench and sort
various planning reports, the planner is required for ASCP to generate
recommendations. The planner also must approve any move orders
requesting the item. Define planner codes with the Planners form;
optionally specify their employee name and e-mail address.
- Make or Buy This field, along with sourcing rules (described in Chapter 11),
controls the default order type planned for the item. If it is set to "Make,"
planning explodes the item's bill of material and suggests discrete jobs to
satisfy demand; if it is set to Buy, planning will not explode a bill of material
and will suggest purchase requisitions. You can override the suggested
order type based on the setting of the Purchasable and Build in WIP attributes. (This field also determines the default of the Based on Rollup
attribute in Oracle Cost Management.)
- Order Quantity Modifiers -- Minimum, Maximum, Fixed Order Quantity,
and Fixed Lot Multiplier These attributes determine the quantity of the
planned orders that MRP or ASCP can suggest; use them if there is a natural
or economic lot size for the item (e.g. certain products are not practical to
order in small or odd quantities; others might require a separate order if the
order would be more than a full truckload, etc.). But use these with caution
in a "lean" manufacturing environment; they can inflate order quantities
and contribute to excessive inventory levels.
- Fixed Days Supply This attribute, sometimes called "period of supply,"
tells planning to generate planned orders to cover requirements for a certain
number of working days. This will limit the total number of orders that are
generated over time, but will result in overall higher inventory levels;
consider using it for inexpensive items where the cost of ordering exceeds
the carrying cost of the early inventory.
- Safety Stock Method, Bucket Days, and Percent The safety stock method
MRP Planned % tells planning to dynamically calculate safety stock as the
percentage of the average daily demand in the buckets you specify. Non-
MRP Planned means that safety stock levels come from Oracle Inventory,
either calculated by the Reload Safety Stocks concurrent program in Oracle
Inventory, or manually entered on the Enter Item Safety Stock form.
NOTE
Non-MRP Planned does not imply that planning
will ignore safety stock in its calculation; it simply
identifies the source of the desired safety stock
levels. Whether or not planning uses safety stock in
its processing is controlled by the plan attribute Plan
Safety Stock.
Mix-Max Quantity information is not used by MRP or ASCP. Cost information is
used in ASCP optimization; Source information is one method of defining a supply
chain; both of these topics are discussed in Chapter 11.
MRP/MPS Planning Attributes
The MRP/MPS Planning Attributes tab (see Figure 8-14) includes the fields that pertain
specifically to MRP planning. The following fields are important:
- Planning Method The planning method determines the types of plans in
which an item participates.
- Forecast Control This attribute controls forecast explosion and
consumption, as described earlier.
- Pegging This determines the pegging information calculated by the plan.
End assembly pegging maintains a "peg" or link to the end assembly
responsible for the demand; Soft pegging maintains a link to the immediate
source of the demand; Hard pegging is used for Project MRP. Various
combinations of these values are allowed.
- Exception Set The exception set controls certain types of exceptions. To
define exception sets on the Planning Exception Sets form, give each set a
name and set the sensitivity and time period for six types of exceptions:
Shortages, Excess inventory, Overpromised inventory, Repetitive variances,
Resource over-utilization, and Resource under-utilization. You may have
different exception sets for different classes of items; for example, your
definition of "excess" inventory will probably vary for inexpensive, fastmoving
items versus expensive, slow-movers. Note that if an item has no
exception set, the exceptions listed here will not be reported for the item.
- Shrinkage Rate The shrinkage is a decimal factor, usually small, that reflects
an anticipated loss of the item during its manufacture or procurement;
planning will inflate order quantities to account for this expected loss.
Compare this with component yield, discussed later in this chapter.
- Acceptable Early Days This attribute filters out some "nervousness" in
the plan. It suppresses "reschedule out" suggestions for existing orders if
the order would be rescheduled by less than the number of acceptable
early days. In other words, it defines how many days early an order can
be before planning will suggest rescheduling it out.
- Round Order Quantities If enabled, this check box tells the planning
process to round planned order quantities up to the next higher integer.
Note that this affects planned orders only; it does not directly affect the
calculation of dependent demand or of WIP requirements, which may
be fractional due to yield factors.
- Repetitive Planning attributes Overrun % and Acceptable rate increase
and decrease, as described earlier in the "Repetitive Planning" section.
- Calculate ATP This check box determines whether planning calculates and
prints the available to promise on the Planning Detail Report; it does not
affect the calculation of ATP for Order Management or Inventory inquiries.
- Reduce MPS This attribute lets you reduce master production schedule
quantities based on the passage of time; use this only if you are not relieving
the MPS through the creation of WIP jobs or purchase requisitions/orders
(e.g., if you're using an external system for those functions).
- Time Fences You can specify a Planning Time Fence, which prevents new
order creation or reschedule in suggestions; a Demand Time Fence, which
you can use to ignore forecast demand either in planning or in loading an
MDS; and a Release Time Fence, to define the window within which planning
can automatically release orders from plans designated as Production. You
define the length of each time fence either as a fixed number of work days
or as the item's Total lead time, Cumulative total lead time, or Cumulative
manufacturing lead time. Note that the use of the Planning and Demand
Time Fences is further controlled by attributes of each individual plan.
Lead Times
Lead times in Oracle are divided into several elements. The relationship between

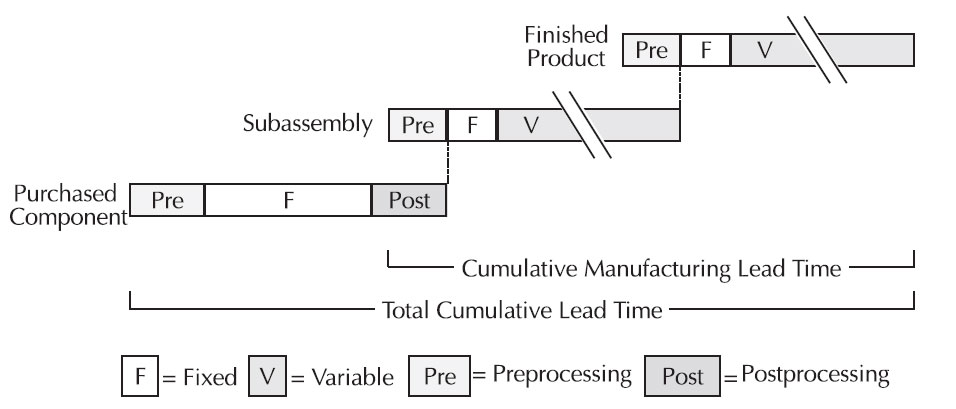

these elements and the various types of lead time is shown in Figure 8-15.
- Preprocessing The time it takes to prepare an order for release; this might
be the time it takes to prepare a shop packet for manufacturing or to prepare
a purchase order. This is sometimes referred to as paperwork lead time.
- Fixed The portion of an item's lead time that does not vary with the order
quantity. Setup time is a typical example; this is often a fixed amount of
time, regardless of the size of the order. Planning uses fixed lead time to
plan both manufacturing and purchase orders.
- Variable The portion of lead time that varies with the order quantity.
Planning uses variable lead time to plan manufacturing orders only.
- Processing The time it takes for a supplier to fulfill your purchase order
once released or the typical time it takes to complete a discrete job for the
item. For manufactured items, this can be calculated from the fixed and
variable lead times and represents the time it takes to manufacture the Lead
time lot size quantity of the item; as such, it is an average. It is used to
calculate the cumulative lead times. Planning does not use processing lead
time at all for manufactured items; it uses the combined fixed and variable
lead time. For purchased items, planning will use the processing lead time
only if you do not specify a fixed lead time for the item.
- Postprocessing The time it takes to put away purchased material after it is
received. Planning uses this for purchased material only; for manufactured
items, you should include this in your routings if it is significant.
You can calculate fixed, variable, and processing lead times from your routing
time, as described in Chapter 4. This process uses the lead time lot size, which you
also specify on this tab.
The Lead Times tab also includes two types of cumulative lead time:
- Cumulative Total The "critical path" lead time, or the time it takes to
buy the first piece of raw material, manufactures all the subassemblies
and makes the item.
- Cumulative Manufacturing The cumulative lead time for manufacturing
activities only; this is the cumulative total lead time, minus the purchasing
lead time.
Cumulative lead times can be used to set the different planning time fences or
the Infinite Supply Horizon in Oracle Inventory ATP rules. Using a cumulative lead
time instead of a user-defined number of days means that these fences and horizons
can shrink as you reduce lead times, without additional maintenance. Cumulative
lead times are also helpful in reviewing proposed engineering changes; if you schedule
a change inside an item's cumulative lead time, you may require expediting of
material to satisfy the new demand. You can calculate cumulative lead times with
the Rollup Cumulative Lead Times concurrent program after you have calculated or
entered your item lead times.
Purchasing and WIP Attributes
The Purchasable and Build in WIP attributes control what types of orders you can
release from the Planner Workbench. One or both of these must be enabled to
allow you to release orders. The Make or Buy attribute and sourcing rules control
the default type of order that is suggested, but you can override the suggestion with
a different order type if the appropriate attribute is enabled.
BOM Information
The following component information from your bills of material is worth special
mention in terms of planning:
- Operation Seq Identifies the routing operation at which the component is
consumed. If you are planning by Operation Start Date, this information is
used along with the Lead Time % from the item's routing to estimate when
the component is needed. If your plan options specify planning by Order
Start Date, this information is irrelevant for planning purposes; all material
is planned to be available at the start of the job.
- Planning Percent Used in forecast explosion and in planning for Model,
Option class, and Planning bills of material. The planning percent reflects
the anticipated distribution of the component. Note that planning percents
do not have to equal 100 percent. Certain optional components in a model
will naturally total something other than 100 percent usage, and you can
explicitly over- or underplan if you choose.
- Yield A decimal factor that represents the anticipated loss (or gain) of the
component in manufacturing. Note that yield is expressed as a decimal
factor and defaults to 1. A yield of .98, for example, represents that you
expect to lose 2 percent of the component in the manufacturing process;
planning will inflate the gross requirements of this component accordingly.
Compare this with the item attribute Shrinkage; shrinkage represents an
anticipated loss of the assembly in manufacturing or a purchased part
during the procurement cycle. Planning will inflate the order quantity to
account for shrinkage. It is expressed as a decimal quantity and defaults
to 0. A shrinkage of .02, for example, indicates that you expect to reject 2
percent of the material during incoming inspection if it's a purchased part.
These two factors, shrinkage and yield, are often confused. Though it is
sometimes possible to manipulate the factors to give the same result, they
are intended to model two very different events.
- Material Control For the most part, the material control attribute affects
manufacturing execution, but two values have special significance in
planning. A value of Supplier is intended to identify a part that is provided by your supplier as part of outside processing; you are not responsible for
procuring this part, so planning will not plan it. A value of Phantom invokes
planning's phantom-part logic; it will "blow through" these parts and plan
for their components directly. (Internally, planning actually does generate
orders for the phantom, but these orders are visible on the Planner
Workbench only if you query them explicitly.)
Planning Manager
The Planning Manager is a concurrent program (not a Concurrent Manager, despite
the name); its function is to manage many of the "housekeeping" activities required
in the planning environment. For example, the Planning Manager performs forecast
consumption and master schedule relief. It also processes the forecast and master
schedule interfaces, validating the data and populating the forecast and master
schedules tables.
It is important that the Planning Manager be active. If it is not, you might see
some unexpected results in planning. For example, you will not see discrete jobs or
purchase orders for master schedule item in your plans; the rationale is these might
not have been reviewed for master schedule relief, and if that relief did not occur,
planning might overstate the master schedule.
The Planning Manager typically runs continually in a production environment,
though the program itself executes on a regular interval; during the day it will execute
and then schedule itself (with the same concurrent request ID) to run again. The
next day, a new concurrent request ID will be assigned.
You can determine if the Planning Manager is active by examining the Active check
box on the Planning Manager form, by using the View Requests form (the program
should be running or pending), or by examining its log file for recent activity. You
start the Planning Manager on the Launch Planning Manager form; the only parameter
required is the Processing Interval. Oracle recommends starting with the default
interval of 30 seconds.
Summary
This chapter covered the common features of single-organization MRP and multiorganization
Advanced Supply Chain Planning. It described the planning process
and basic forecasting, master scheduling, and capacity planning terminology and
activities. This chapter described engineering's impact on planning and the unique
characteristics of repetitive planning and kanban planning. It also covered basic
setup steps, including the critical item and bill of material attributes that control the
planning process.
The following chapters provide details on Oracle Demand Planning and the
unique features of MRP and ASCP.
